CLC/Guillemot Expedition Single - Hull #23

This boat will be built with strapless hatches, recessed deck fittings, and a custom strip pattern.

Length:  19 feet
Beam:  21 inches
Weight: ~42 lbs.
Photos of the completed project.

Click on photos for slideshow

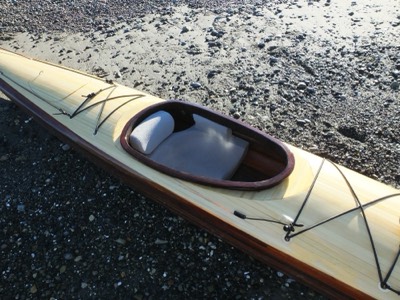

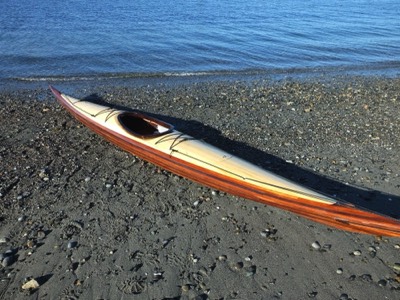

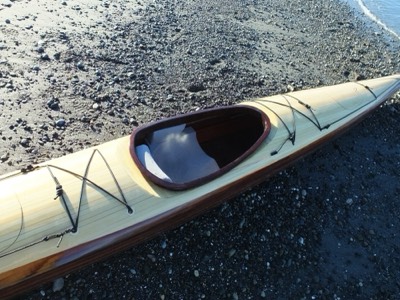

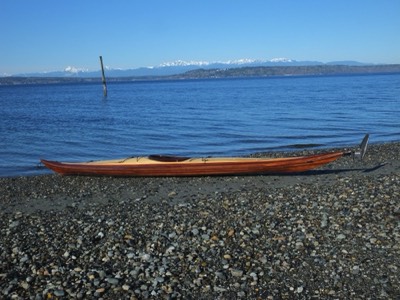

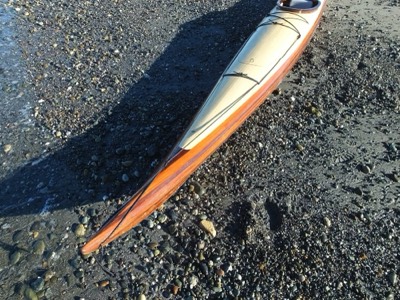

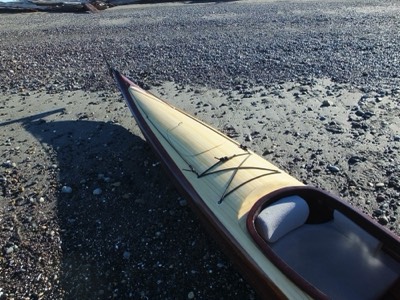

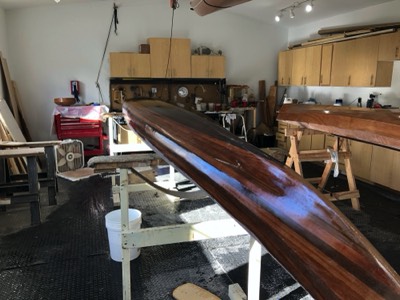

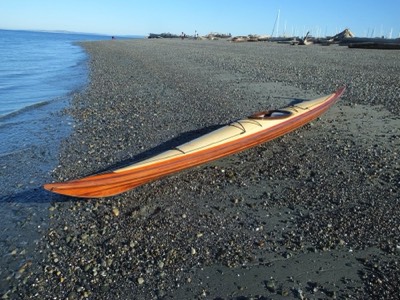

  •  3/20/19 - The boat is complete!

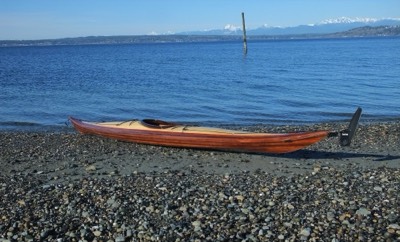

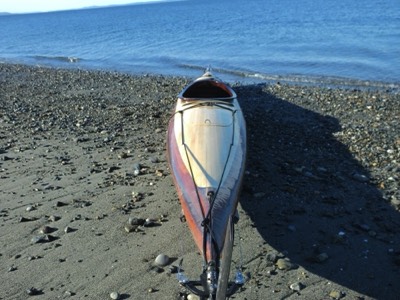

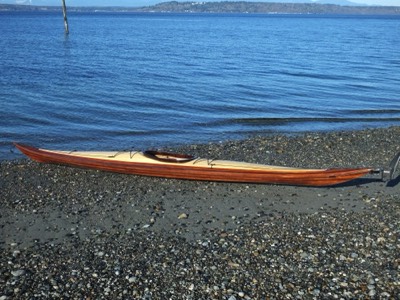

    3/20/19 - The boat is complete!

  •  Guillemot Expedition Single

    Guillemot Expedition Single

  •  Guillemot Expedition Single

    Guillemot Expedition Single

  •  Guillemot Expedition Single

    Guillemot Expedition Single

  •  Guillemot Expedition Single

    Guillemot Expedition Single

  •  Guillemot Expedition Single

    Guillemot Expedition Single

  •  Guillemot Expedition Single

    Guillemot Expedition Single

  •  Guillemot Expedition Single

    Guillemot Expedition Single

  •  Guillemot Expedition Single

    Guillemot Expedition Single

  •  Guillemot Expedition Single

    Guillemot Expedition Single

  •  Guillemot Expedition Single

    Guillemot Expedition Single

  •  Guillemot Expedition Single

    Guillemot Expedition Single

  •  Guillemot Expedition Single

    Guillemot Expedition Single

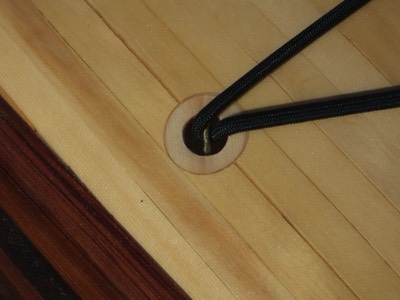

Stacks Image 206
Click here for a video walk-around of the kayak.

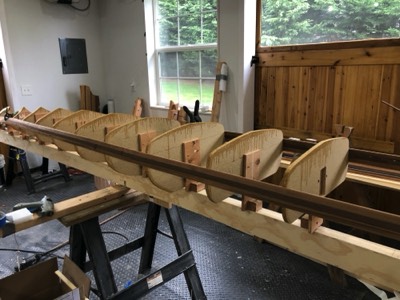

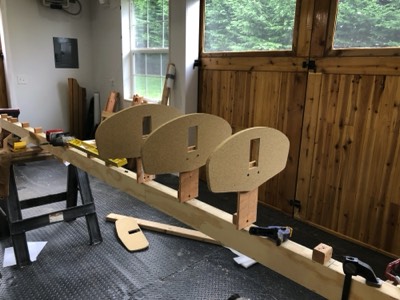

  •  12/10/18 - The strongback is set up and three forms are in place.

    12/10/18 - The strongback is set up and three forms are in place.

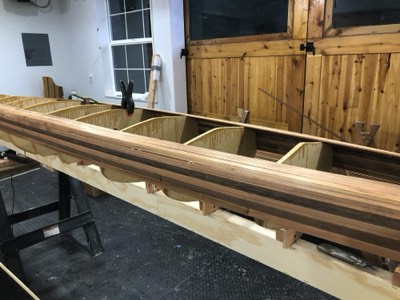

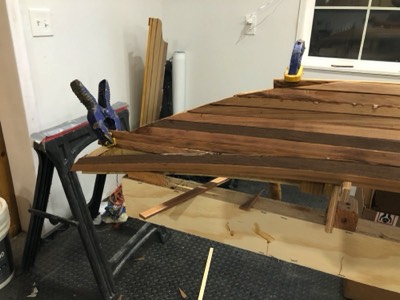

  • 12/14/48 - Three strips per side are in place.

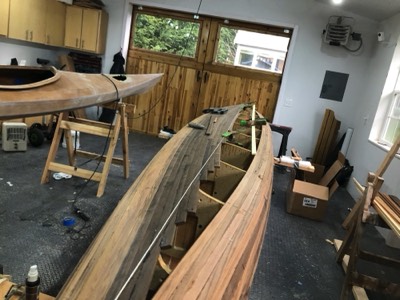

  •  Nine strips are in place on the starboard side.

    Nine strips are in place on the starboard side.

  •  Cheater strips are added to fill in the gap at the bow.

    Cheater strips are added to fill in the gap at the bow.

  •  A string is used to mark the centerline.

    A string is used to mark the centerline.

  •  One and a half strips left!

    One and a half strips left!

  •  View from a different angle.

    View from a different angle.

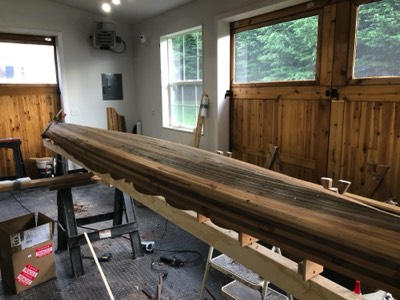

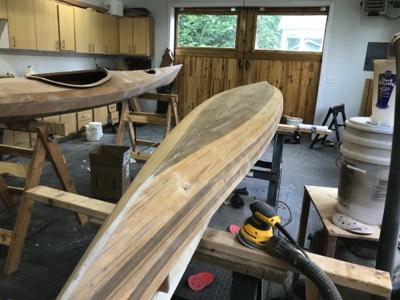

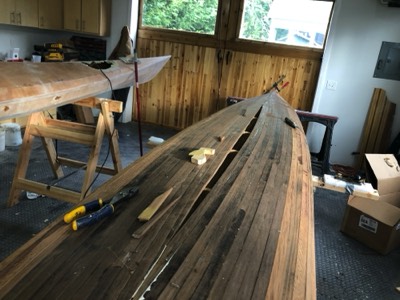

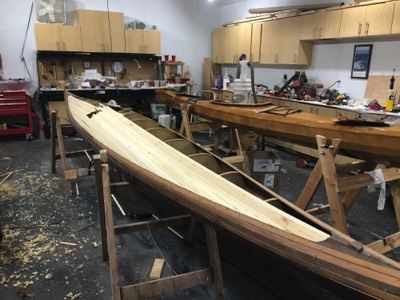

  •  The hull is sanded.

    The hull is sanded.

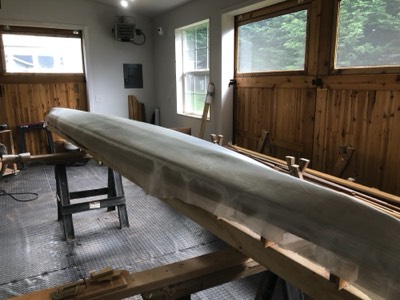

  •  1/4/19 - Fiberglass cloth is draped over the hull.

    1/4/19 - Fiberglass cloth is draped over the hull.

  •  The fiberglass is saturated with epoxy.

    The fiberglass is saturated with epoxy.

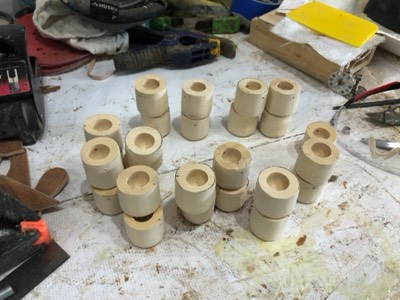

  •  1/8/19 - Recessed deck fittings pieces are sanded to shape.

    1/8/19 - Recessed deck fittings pieces are sanded to shape.

  •  1/9/19 - The hull is flipped over.

    1/9/19 - The hull is flipped over.

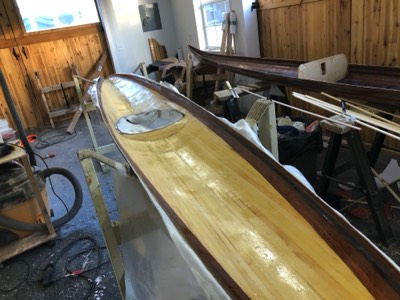

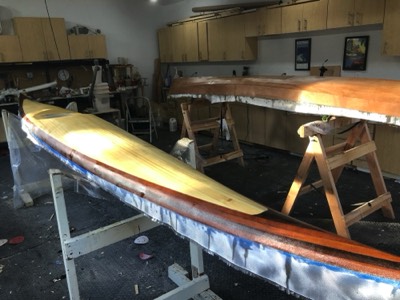

  •  The starboard side of the deck is done.

    The starboard side of the deck is done.

  •  1/23/19 - Any gaps between strips are filled with epoxy.

    1/23/19 - Any gaps between strips are filled with epoxy.

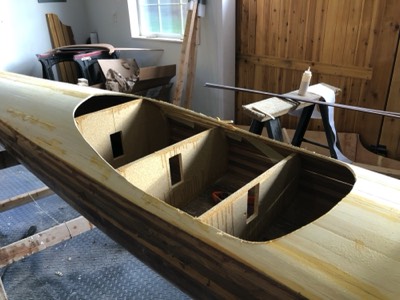

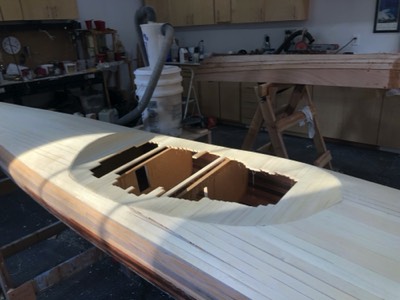

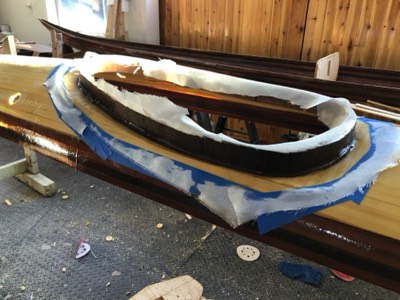

  •  The cockpit recess is cut out.

    The cockpit recess is cut out.

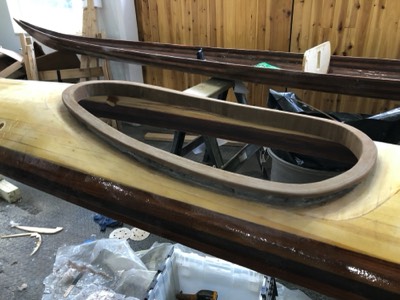

  •  Close up of the recessed cockpit.

    Close up of the recessed cockpit.

  •  1/28/19 - The deck is fiberglassed.

    1/28/19 - The deck is fiberglassed.

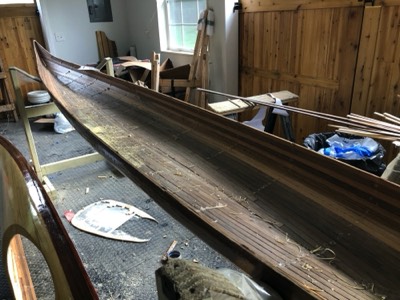

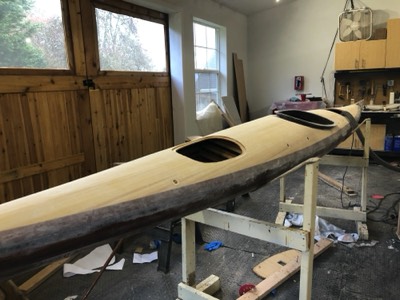

  •  The deck is removed and the forms are taken out.

    The deck is removed and the forms are taken out.

  •  2/4/19 - The underside of the deck is fiberglassed.

    2/4/19 - The underside of the deck is fiberglassed.

  •  The outside of the coaming riser is filletted and fiberglassed.

    The outside of the coaming riser is filletted and fiberglassed.

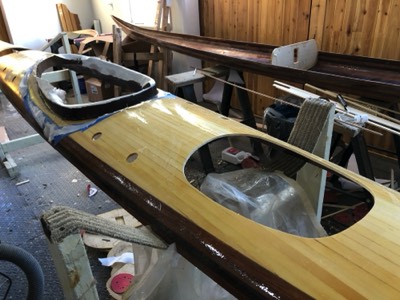

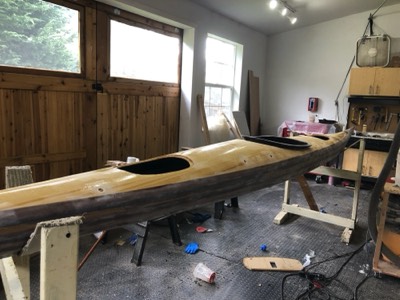

  •  The hatches are cut out.

    The hatches are cut out.

  •  2/13/19 - The cockpit coaming is sanded smooth.

    2/13/19 - The cockpit coaming is sanded smooth.

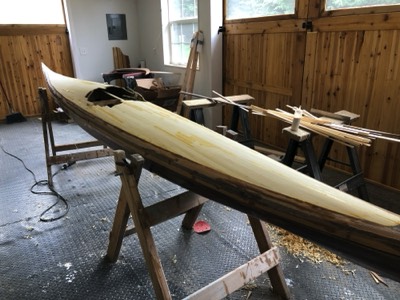

  •  2/22/19 - The deck is sanded and ready for varnish.

    2/22/19 - The deck is sanded and ready for varnish.

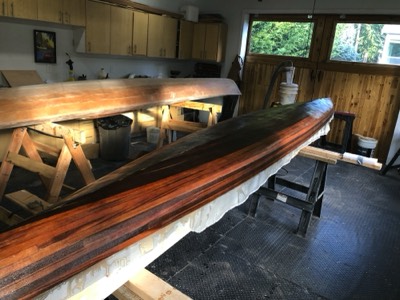

  •  The first coat of varnish is applied to the hull.

    The first coat of varnish is applied to the hull.

  •  2/17/19 - The sheer joint is sanded in preparation for fiberglass reinforcement.

    2/17/19 - The sheer joint is sanded in preparation for fiberglass reinforcement.

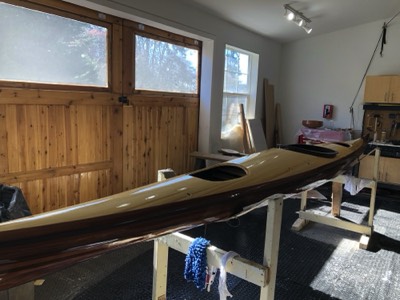

  •  3/1/19 - The first coat of varnish is applied to the deck.

    3/1/19 - The first coat of varnish is applied to the deck.

Click photo for slideshow of selected photos of the construction process.

Link to full construction gallery.
