-
Hull C Construction Phase 1 5/22/20 - The plans are delivered.
-

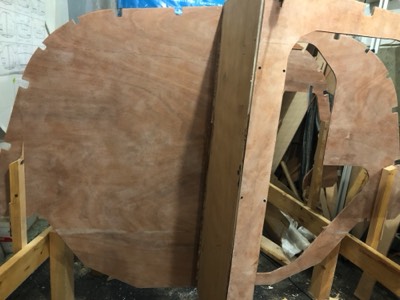

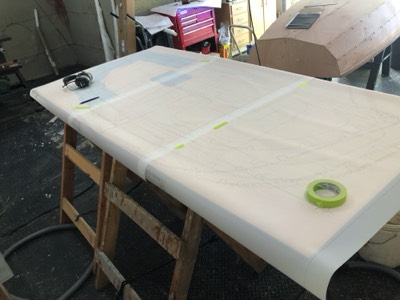

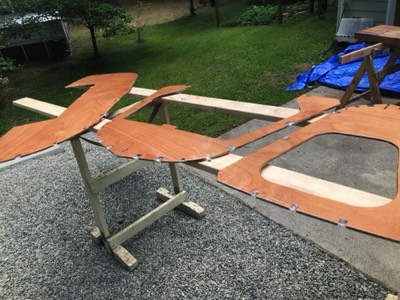

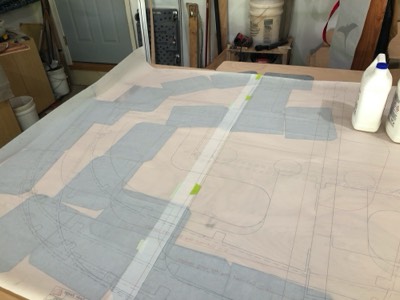

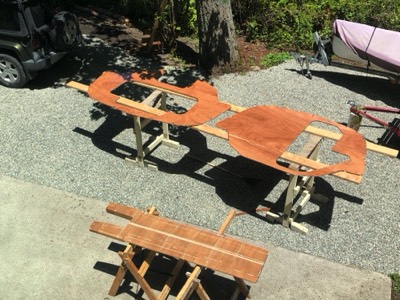

Hull C Construction Phase 1 6/14/20 - Mylar bulkhead patterns are laid out on a piece of plywood.
-

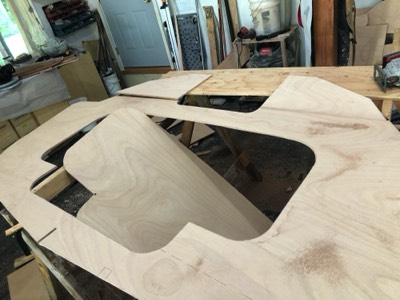

Hull C Construction Phase 1 Bulkhead H is traced onto the wood.
-

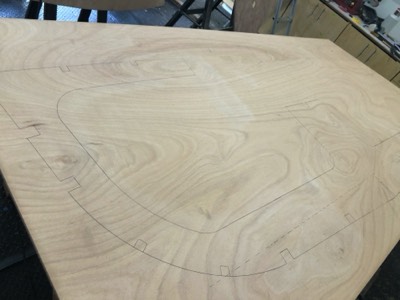

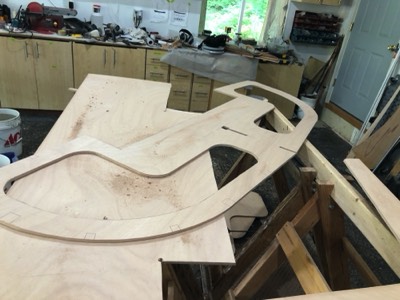

Hull C Construction Phase 1 6/15/20 - Bulkheads are traced onto the plywood.
-

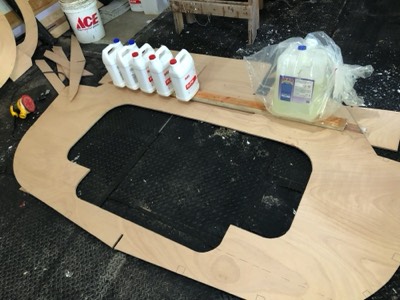

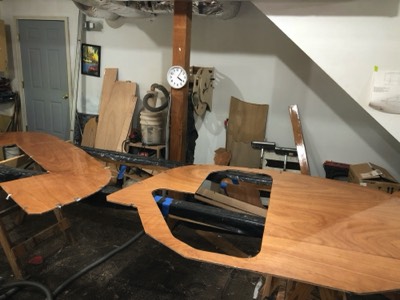

Hull C Construction Phase 1 Bulkheads A and B are cut out.
-

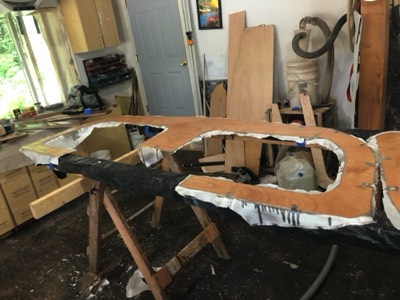

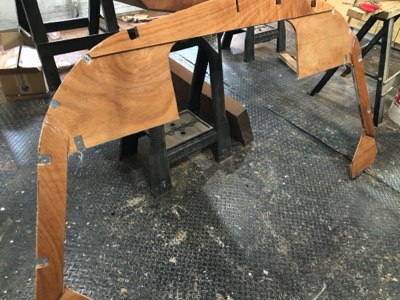

Hull C Construction Phase 1 Transom doubler is cut out.
-
Hull C Construction Phase 1 6/16/20 - Bulkhead G is traced onto the plywood.
-
Hull C Construction Phase 1 Bulkhead G is cut out.
-

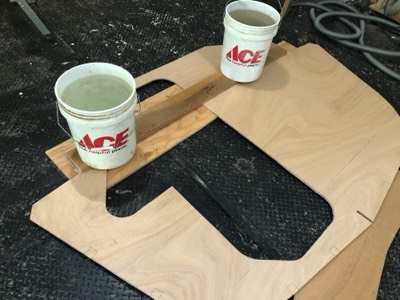

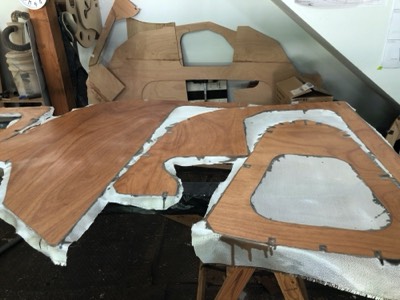

Hull C Construction Phase 1 The upper pieces are epoxied to the main section.
-
Hull C Construction Phase 1 Bulkhead D is epoxied together.
-

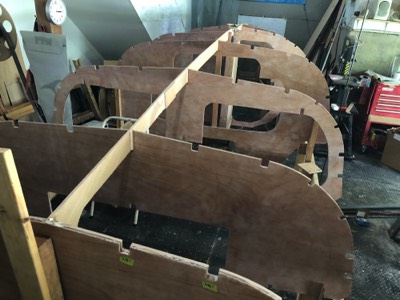

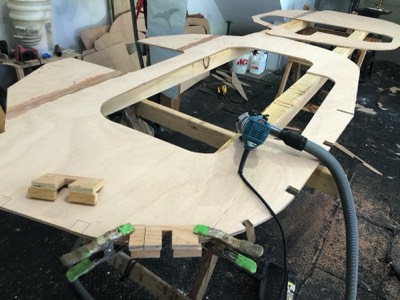

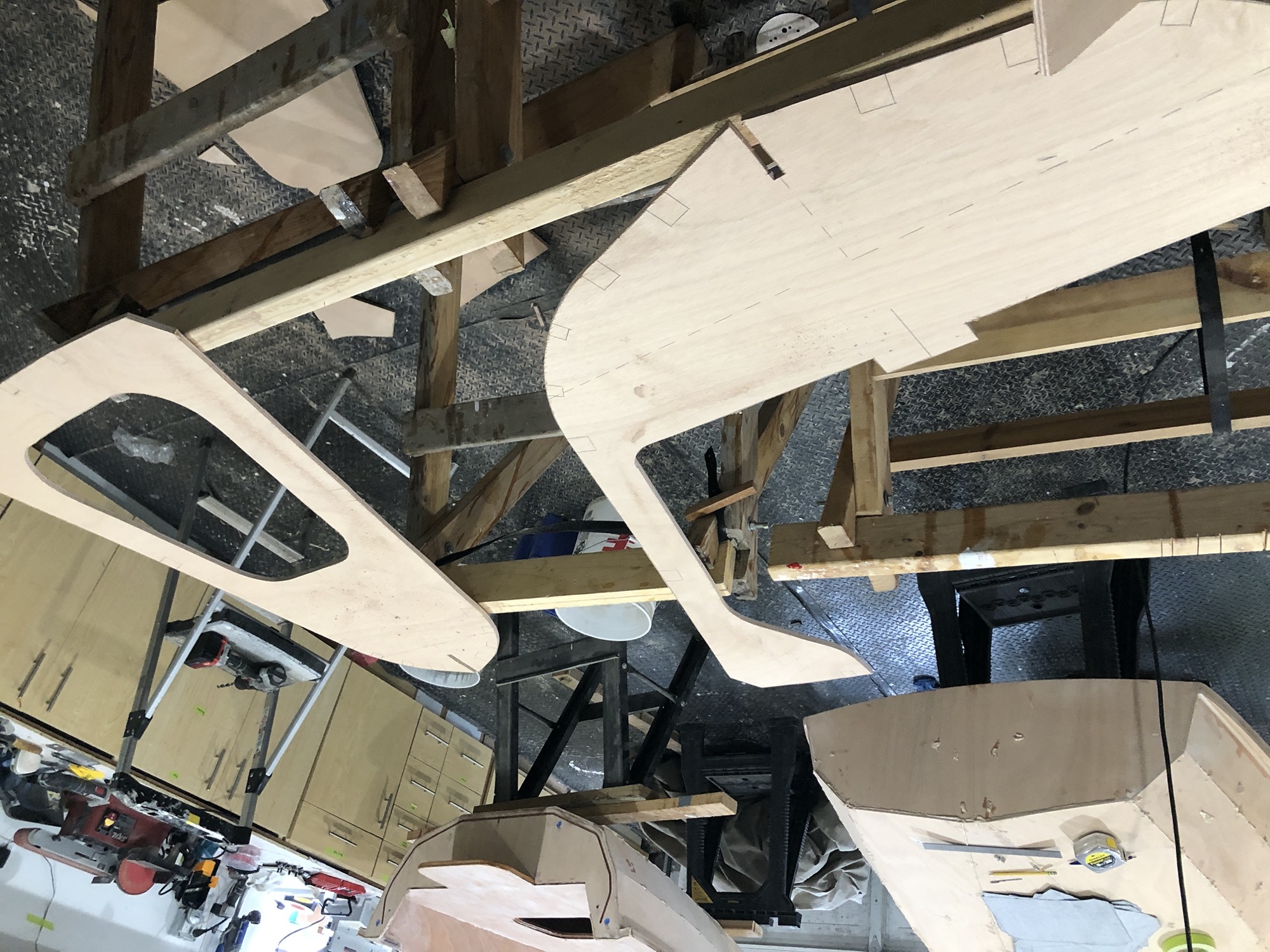

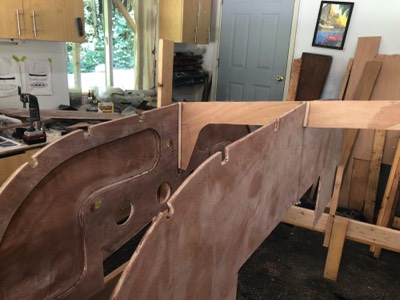

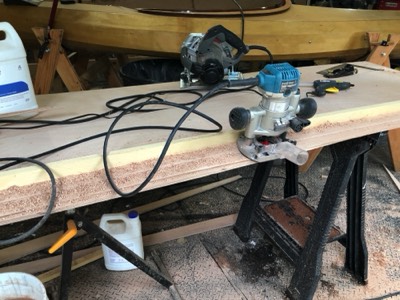

Hull C Construction Phase 1 6/17/20 - Notches for stringers are routed out on all the bulkheads.
-

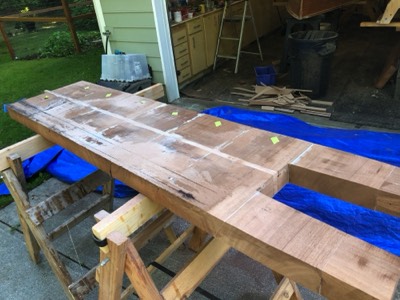

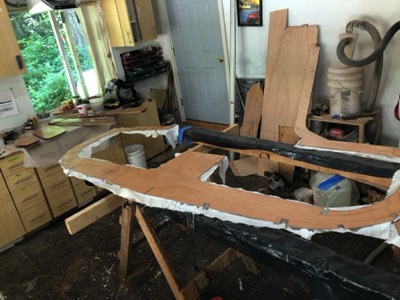

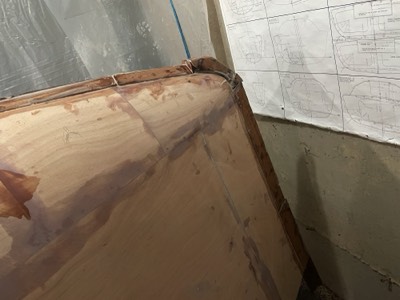

Hull C Construction Phase 1 6/19/20 - The forward end of the backbone is reinforced with extra plywood.
-

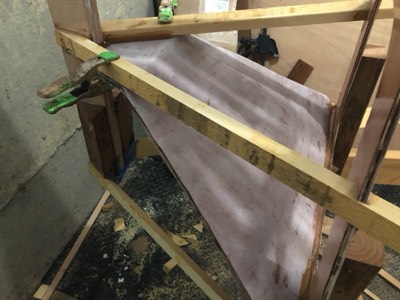

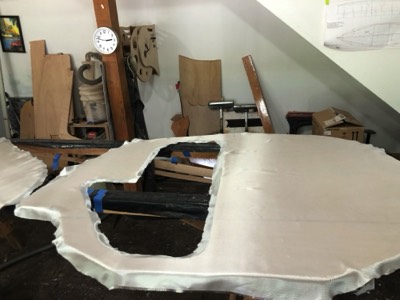

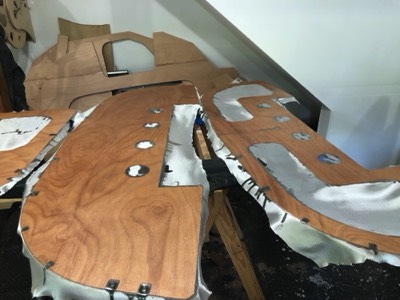

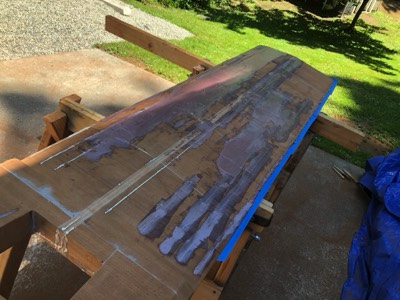

Hull C Construction Phase 1 6/22/20 - The transom and doubler are fiberglassed on one side.
-
Hull C Construction Phase 1 Three other bulkheads are fiberglassed on one side.
-
Hull C Construction Phase 1 The lifing keel is ready for shaping.
-

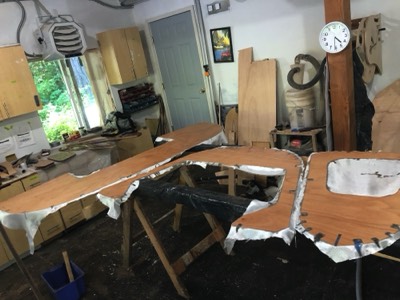

Hull C Construction Phase 1 6/23/20 - Bulkheads E and F are fiberglassed.
-
Hull C Construction Phase 1 Bulkhead H is fiberglassed.
-
Hull C Construction Phase 1 Previously glassed bulkheads are given epoxy fill coats.
-
Hull C Construction Phase 1 Doublers are epoxed in place on bulkhead B.
-
Hull C Construction Phase 1 6/25/20 - The transom doubler is epoxied to the transom.
-
Hull C Construction Phase 1 Bulkheads B, E, and F are fiberglassed on the other side.
-
Hull C Construction Phase 1 Flipside of bulkhead H is glassed.
-

Hull C Construction Phase 1 6/26/20 - Low areas on the keel are filled with epoxy.
-

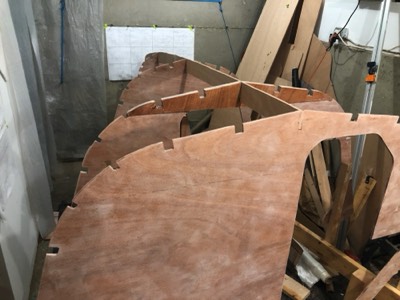

Hull C Construction Phase 1 The last two bulkheads are ready for fiberglass.
-

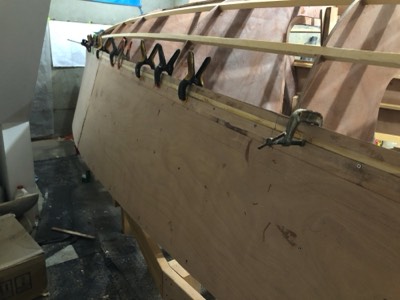

Hull C Construction Phase 1 6/27/20 - Bulkheads D and I are fiberglassed and fill coated.
-
Hull C Construction Phase 1 Bulkhead C is fiberglassed.
-
Hull C Construction Phase 1 6/28/20 - Bulkhead D is ready for fiberglass.
-
Hull C Construction Phase 1 Bulkhead E is ready for fiberglass.
-
Hull C Construction Phase 1 The glass is saturated with epoxy.
-
Hull C Construction Phase 1 The glass is saturated with epoxy.
-

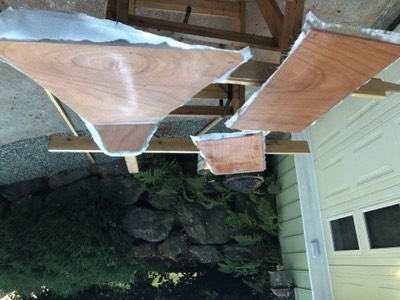

Hull C Construction Phase 1 6/29/20 - Some parts are temporarily moved outside to make room.
-

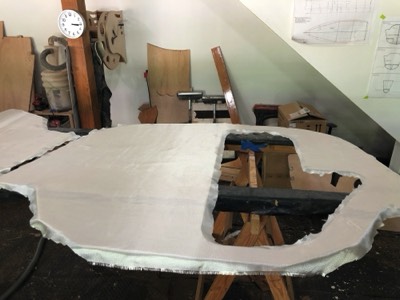

Hull C Construction Phase 1 Fiberglass is laid out on one side of the keel.
-
Hull C Construction Phase 1 The glass is saturated with epoxy.
-
Hull C Construction Phase 1 7/1/20 - The other side of the keel is fiberglassed.
-
Hull C Construction Phase 1 7/3/20 - Carbon fiber cloth is laid onto the keel.
-
Hull C Construction Phase 1 7/5/20 - The inside surface of the keel trunk is coated with an epoxy/graphite mixture.
-

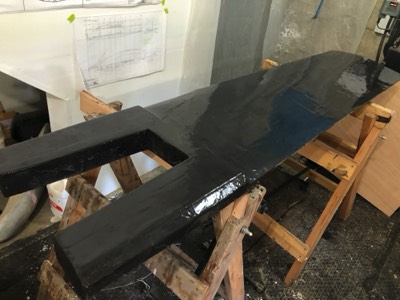

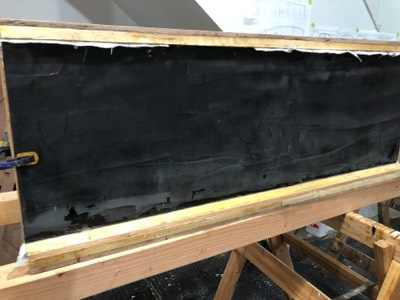

Hull C Construction Phase 1 The keel is coated with an epoxy/graphite mixture.
-
Hull C Construction Phase 1 7/6/20 - The other side of the keel is coated with an epoxy/graphite mixture.
-
Hull C Construction Phase 1 The sides of the keel trunk are epoxied in place.
-

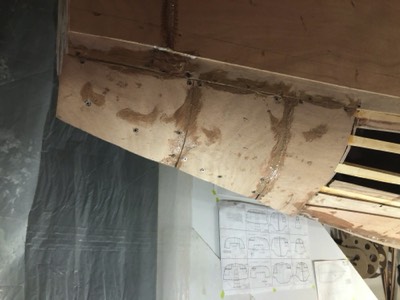

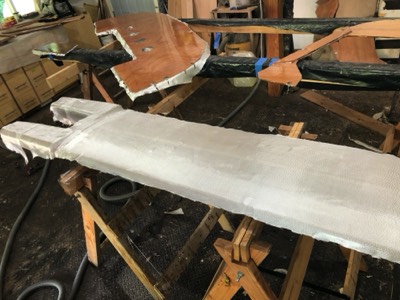

Hull C Construction Phase 1 7/7/20 - The keel trunk sides are fiberglassed.
-

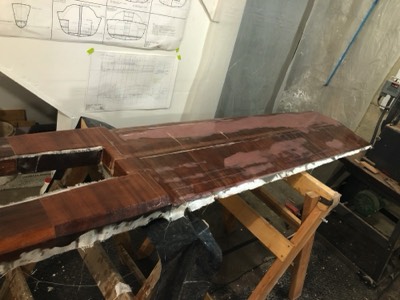

Hull C Construction Phase 1 7/8/20 - The keel is test fit in the keel trunk.
-

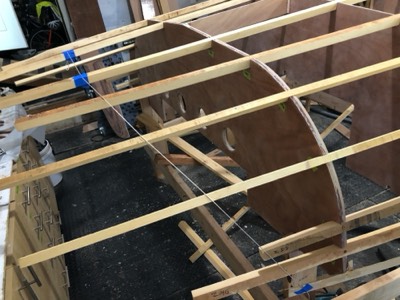

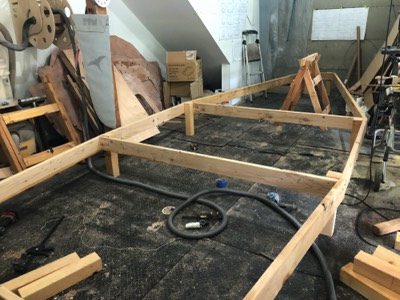

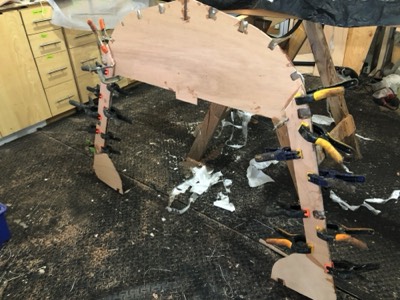

Hull C Construction Phase 1 7/10/20 - The temporary frame is built.
-

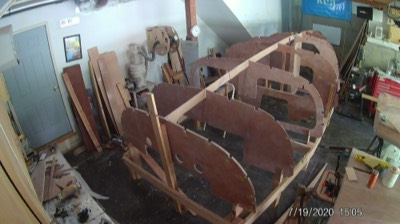

Hull C Construction Phase 1 Bulkheads A, B, and C are fixed into place.
-

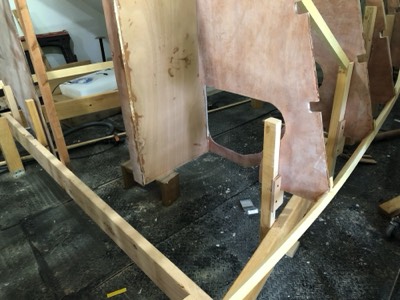

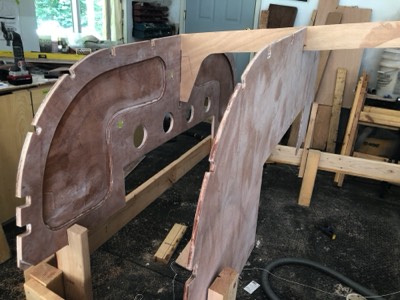

Hull C Construction Phase 1 7/11/20 - Bulkhead D and the forward backbone section are set up.
-
Hull C Construction Phase 1 7/12/20 - The forward half of the backbone is epoxied in place.
-
Hull C Construction Phase 1 7/14/20 - The keel trunk and bulkhead E are epoxied in place.
-

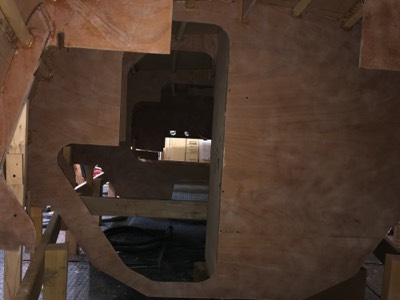

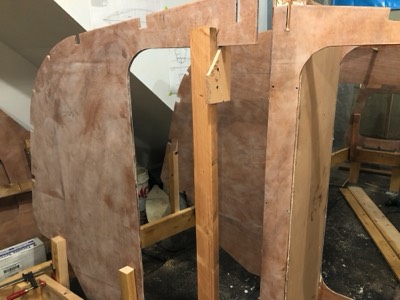

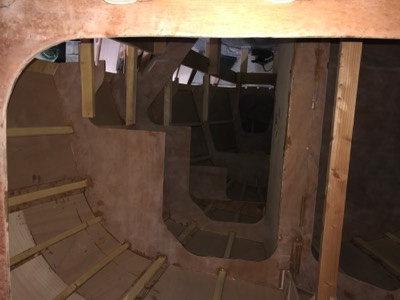

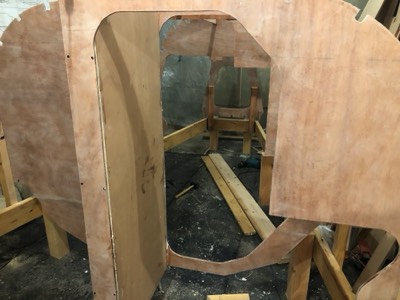

Hull C Construction Phase 1 View of what will be the head compartment.
-

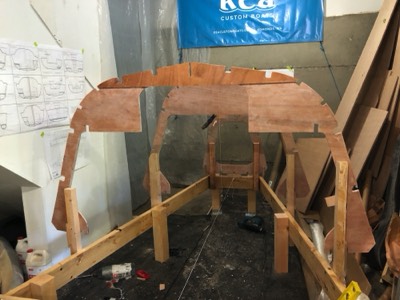

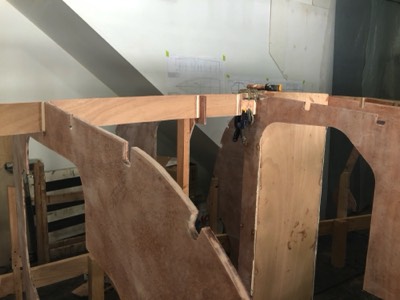

Hull C Construction Phase 1 7/16/20 - Bulkhead F is in place.
-

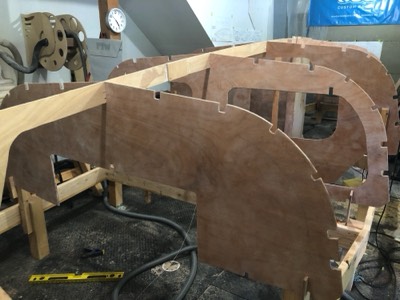

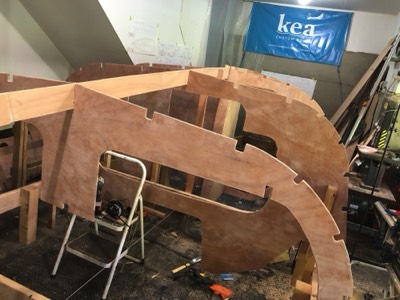

Hull C Construction Phase 1 7/18/20 - Bulkheads G and H are in place.
-
Hull C Construction Phase 1 Bulkhead I in place.
-
Hull C Construction Phase 1 7/19/20 - The transom is fitted.
-
Hull C Construction Phase 1 The transom and bulkhead I are epoxied in place.
-
Hull C Construction Phase 1 Bulkheads G, F, and E are epoxied in place.
-

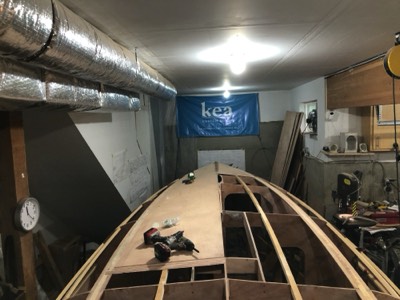

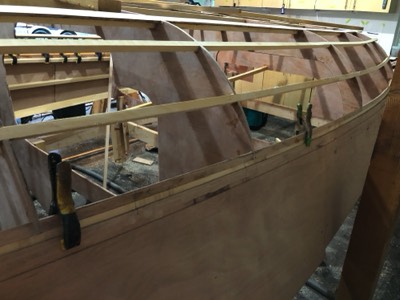

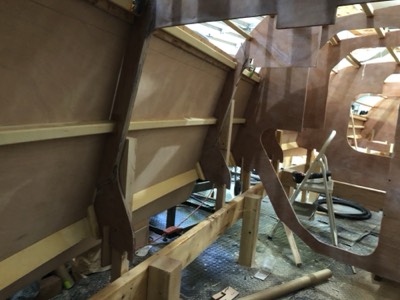

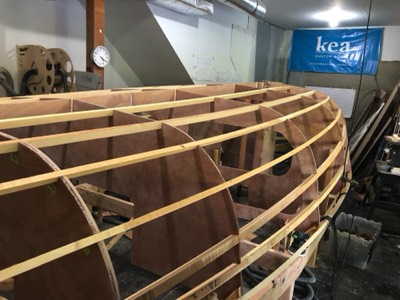

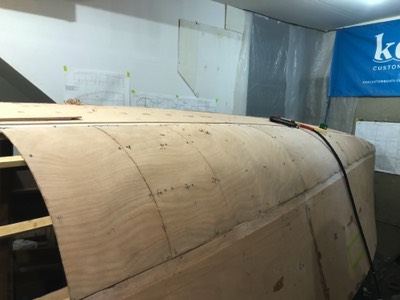

Hull C Construction Phase 1 The boat is ready for stringers.
-
Hull C Construction Phase 1 An overall view.
-

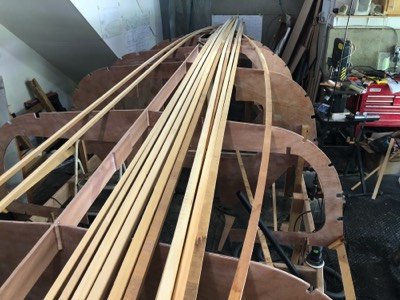

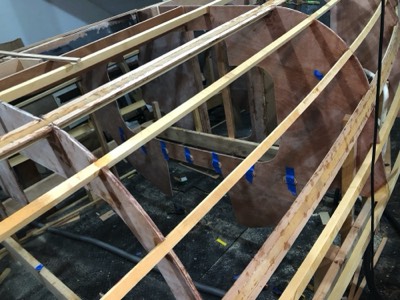

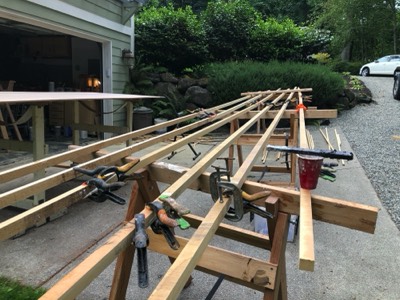

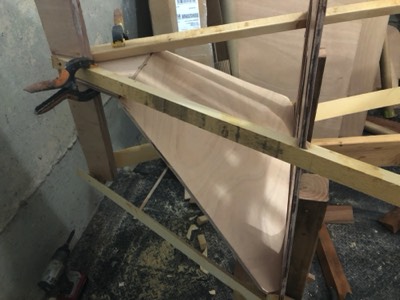

Hull C Construction Phase 1 7/24/20 - Stringers are epoxied to full length using scarf joints.
-
Hull C Construction Phase 1 7/25/20 - The rest of the stringers are epoxied together.
-

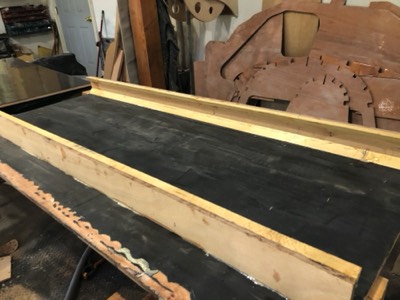

Hull C Construction Phase 1 8/2/20 - The sheer clamp (piece where the deck and hull meet) is epoxied and screwed into place.
-
Hull C Construction Phase 1 8/10/20 - The first stringer is set in place.
-

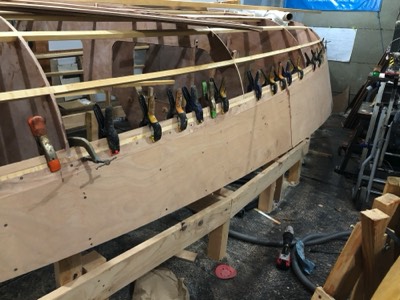

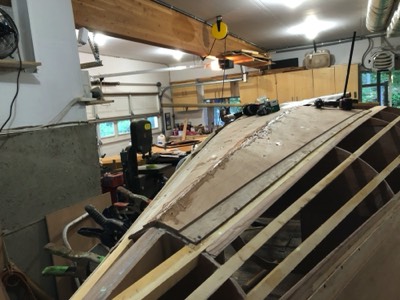

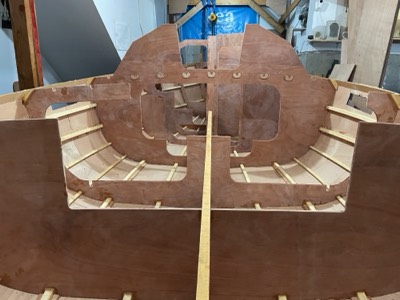

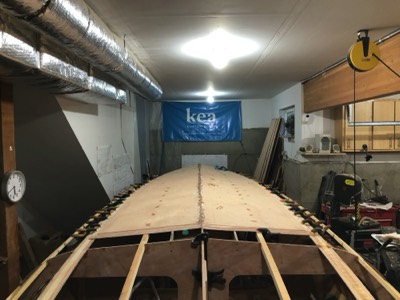

Hull C Construction Phase 1 All of the stringers are in place.
-

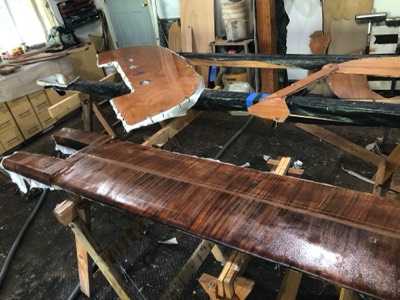

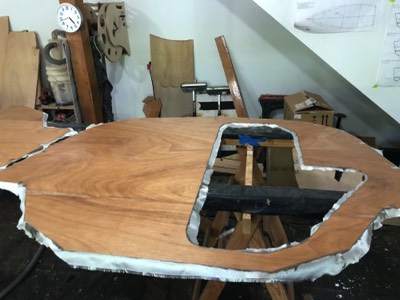

Hull C Construction Phase 1 The shape of the sugar scoop is determined.
-
Hull C Construction Phase 1 View from the bow.
-
Hull C Construction Phase 1 Overall view from the stern.
-

Hull C Construction Phase 1 8/15/20 - The mast is transported home.
-
Hull C Construction Phase 1 8/16/20 - The wall that holds the door into the head is wired in place.
-

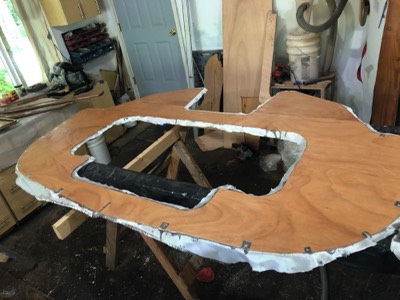

Hull C Construction Phase 1 8/17/20 - The anchor well floor is test fit.
-

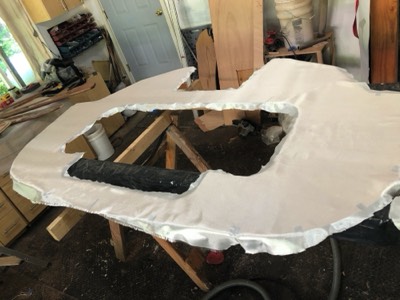

Hull C Construction Phase 1 8/18/20 - The anchor well floor is reinforced with two layers of fiberglass.
-
Hull C Construction Phase 1 8/23/20 - Tangent doublers are epoxied to tangent stringers.
-
Hull C Construction Phase 1 9/2/20 - The cockpit sole support stringer is epoxied in place.
-

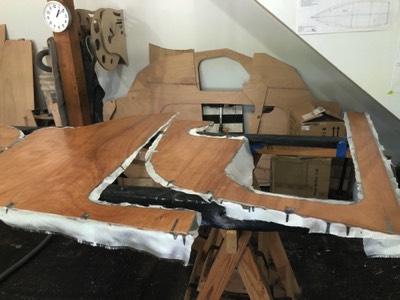

Hull C Construction Phase 1 9/5/20 - The anchor compartment shelf is epoxied in place.
-

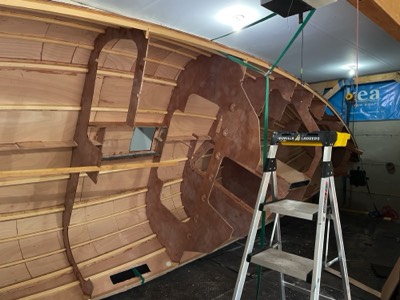

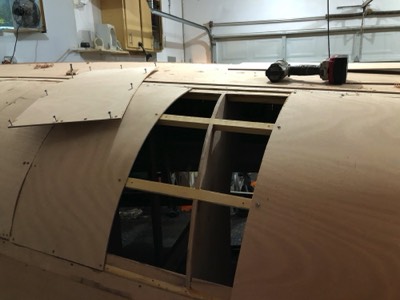

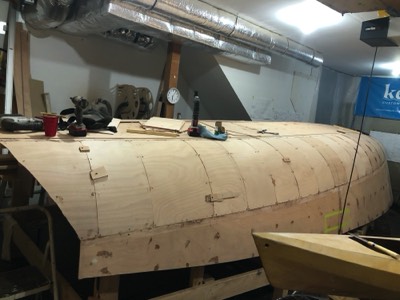

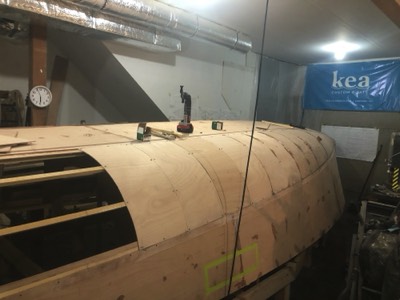

Hull C Construction Phase 1 9/22/20 - Upper hull panels are fit for the starboard side.
-

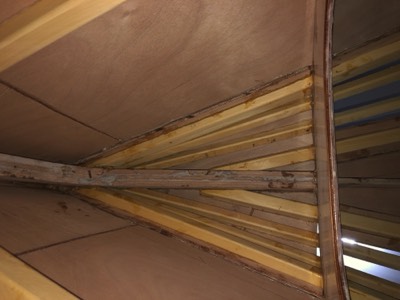

Hull C Construction Phase 1 View from the inside of the boat.
-

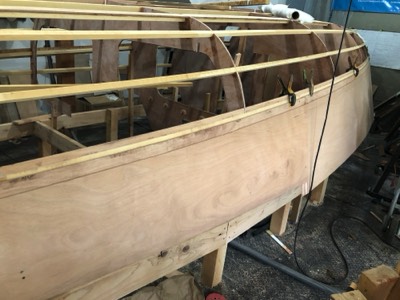

Hull C Construction Phase 1 9/23/20 - The starboard side hull panels are epoxied and screwed in place.
-
Hull C Construction Phase 1 Rabbet is cut in a hull panel.
-

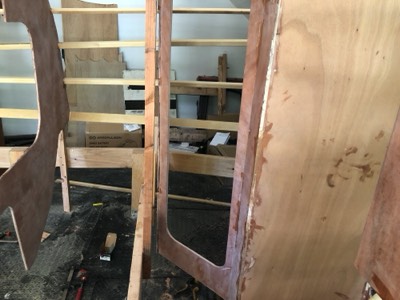

Hull C Construction Phase 1 Port side hull panels are fitted.
-
Hull C Construction Phase 1 9/25/20 - Port side upper panels are epoxied in place.
-
Hull C Construction Phase 1 10/2/20 - First two bottom panels are epoxied in place.
-
Hull C Construction Phase 1 10/7/20 - The starboard middle bottom panel is test fit.
-
Hull C Construction Phase 1 Both middle bottom panels are epoxied in place.
-
Hull C Construction Phase 1 10/9/20 - The last two hull bottom panels are epoxied in place.
-
Hull C Construction Phase 1 View from the port side.
-
Hull C Construction Phase 1 10/13/20 - The first layer of the radius chine panels is begun on the port bow.
-

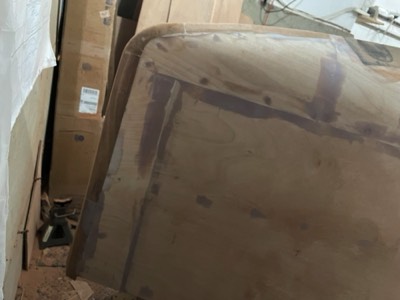

Hull C Construction Phase 1 10/13/20 - Starboard side.
-
Hull C Construction Phase 1 View from inside the bow.
-
Hull C Construction Phase 1 10/14/20 - The first layer of radius panels are test fit on the port side.
-
Hull C Construction Phase 1 The first section is epoxied in place.
-

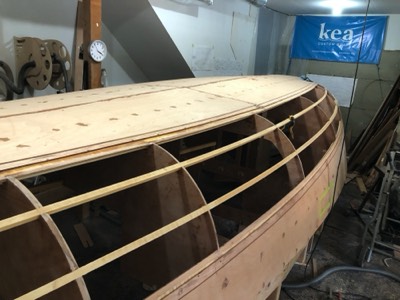

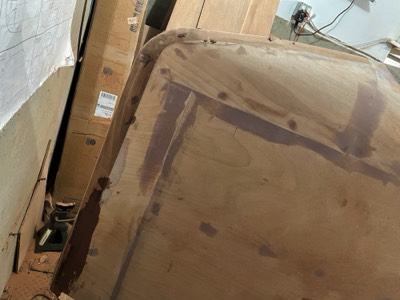

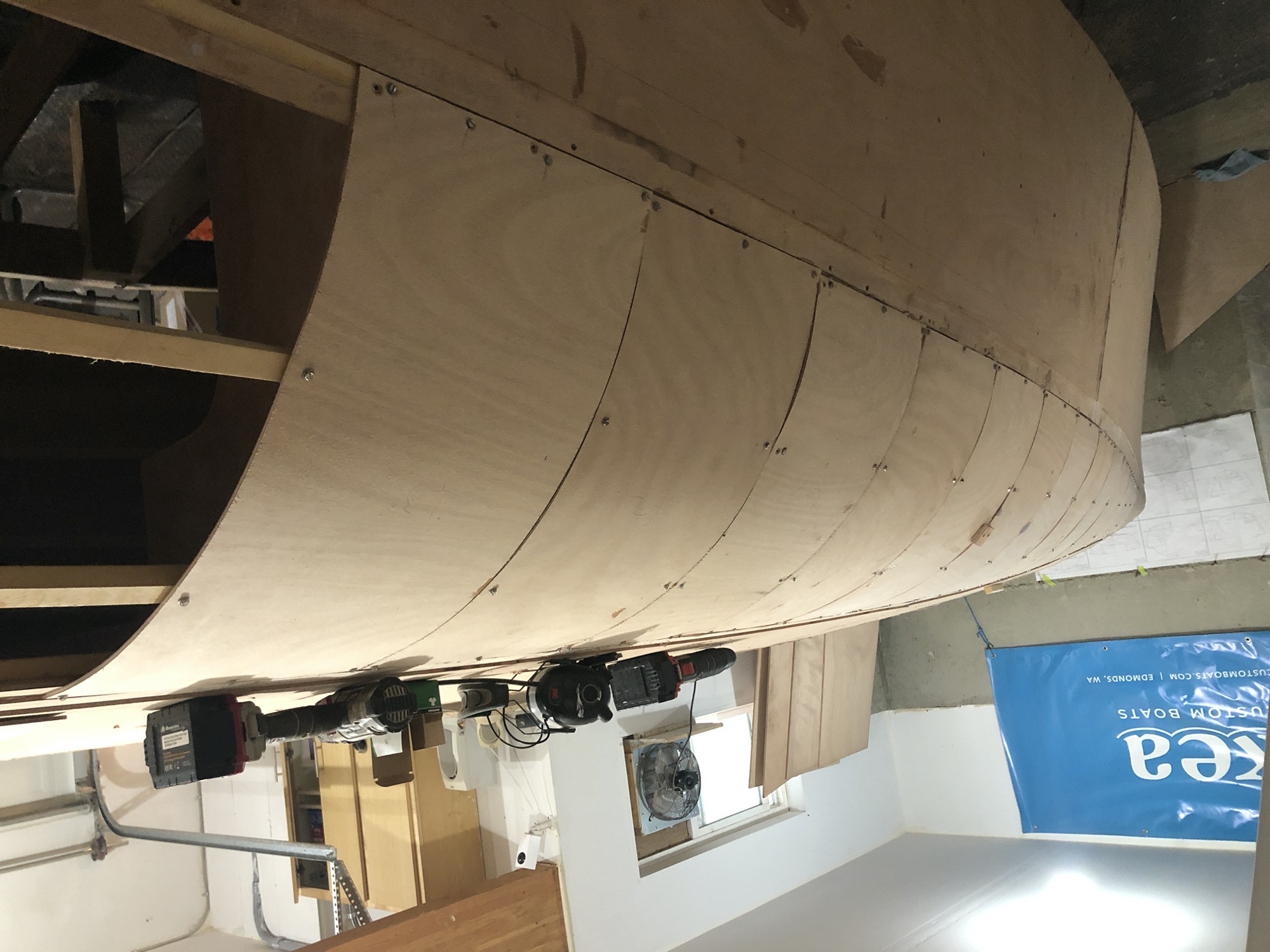

Hull C Construction Phase 1 10/17/20 - The entire first layer of radius panels are epoxied on the port side.
-
Hull C Construction Phase 1 10/18/20 - The starboard side panels.
-

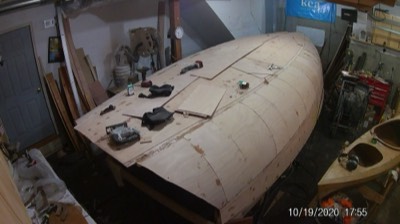

Hull C Construction Phase 1 10/19/20 - One final panel to fit.
-
Hull C Construction Phase 1 All the starboard panels of the first layer are epoxied.
-

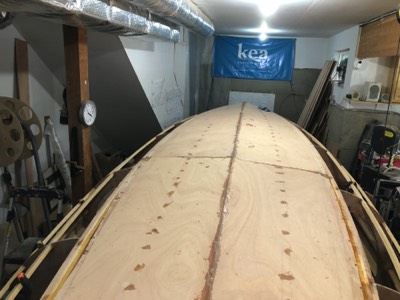

Hull C Construction Phase 1 View from inside.
-
Hull C Construction Phase 1 Overall wide angle view.
-
Hull C Construction Phase 1 10/20/20 - The second layer for the port radius section is going on.
-
Hull C Construction Phase 1 10/22/20 - Several more pieces are epoxied in place.
-

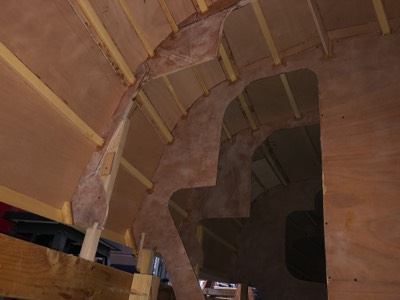

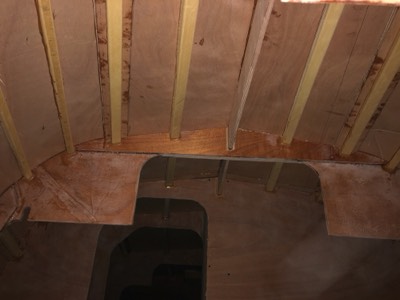

Hull C Construction Phase 1 View of the interior from the v-berth looking aft.
-

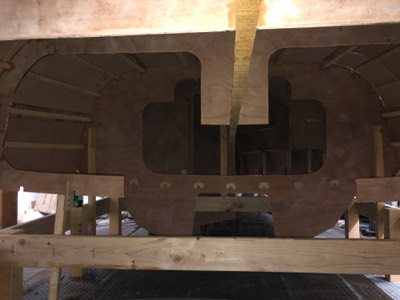

Hull C Construction Phase 1 View of the hull bottom.
-
Hull C Construction Phase 1 Different angle.
-
Hull C Construction Phase 1 View from the port quarter berth looking forward.
-
Hull C Construction Phase 1 10/23/20 - A test piece for mounting flush windows.
-
Hull C Construction Phase 1 A section of the second layer is removed in preparation for epoxy.
-

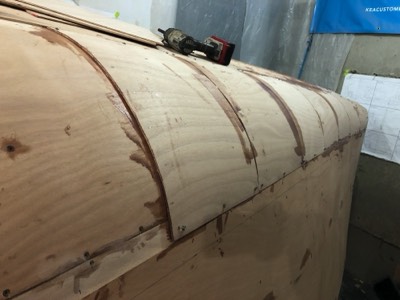

Hull C Construction Phase 1 The entire port side radius is done.
-

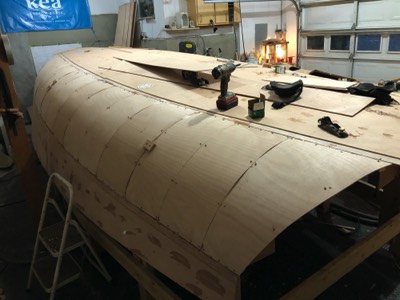

Hull C Construction Phase 1 10/25/20 - Adding the hull panels is complete!
-

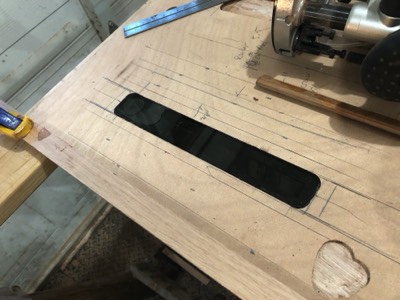

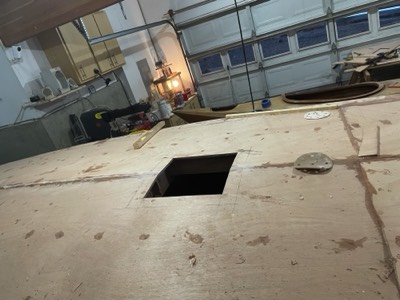

Hull C Construction Phase 1 11/7/20 - The first hull window is cut out.
-

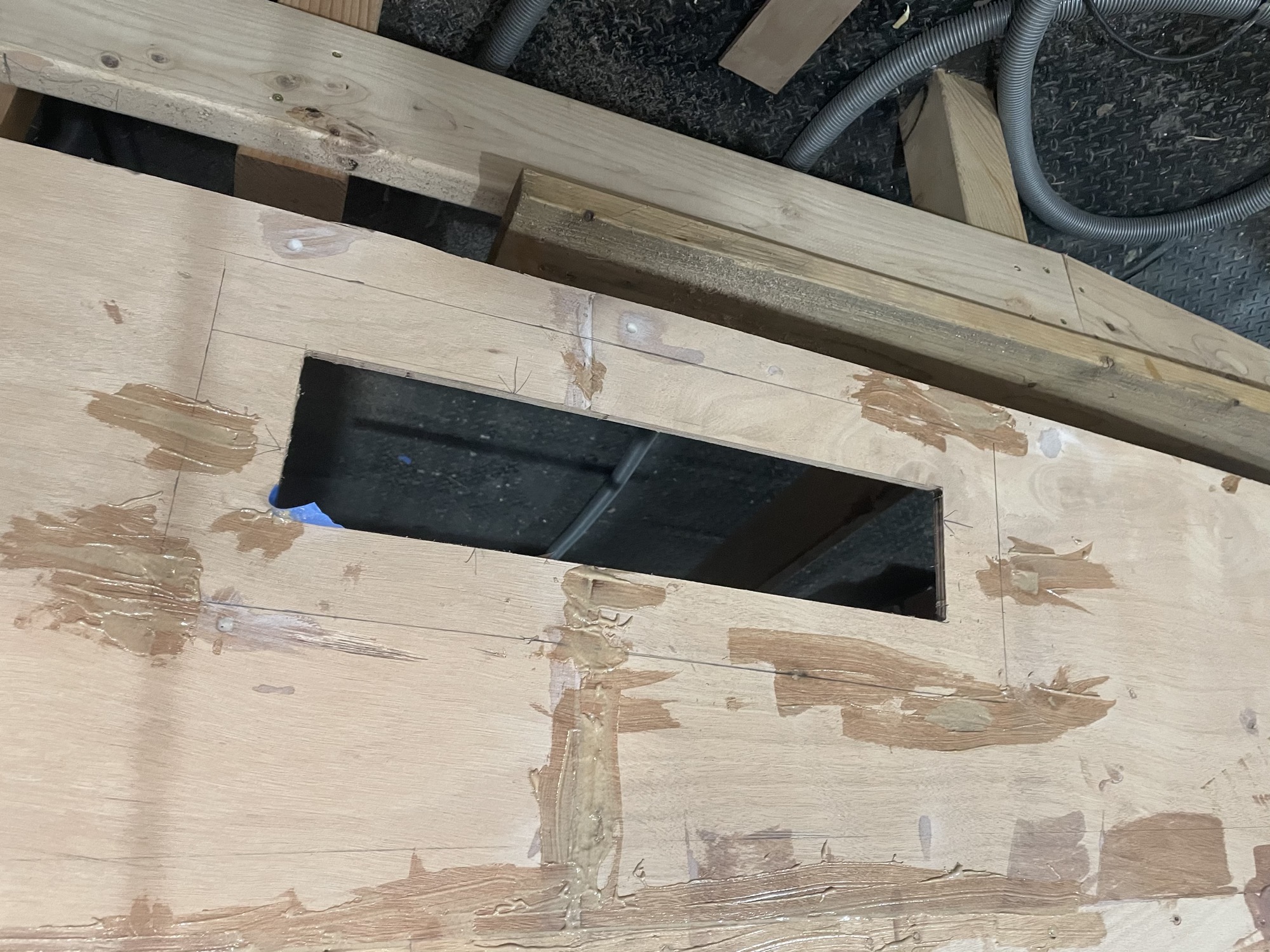

Hull C Construction Phase 1 The hole for the retracting motor is cut out.
-
Hull C Construction Phase 1 11/10/20 - Gaps are filled with epoxy.
-
Hull C Construction Phase 1 Spacer pieces are epoxied in at the end of the sugar scoop.
-
Hull C Construction Phase 1 12/7/20 - Unidirectional carbon fiber is epoxied to the hull to increase the hull stifness.
-

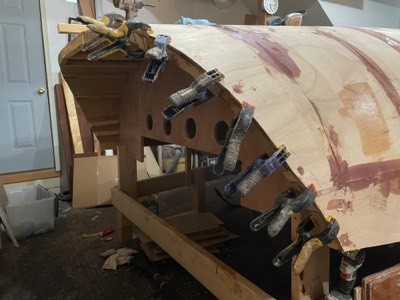

Hull C Construction Phase 1 Extra reinforcment around the chainplate and mast step areas.
-
Hull C Construction Phase 1 12/8/20 - Mahogany pieces are epoxied on the bow stem as an extra protection against low speed collisions.
-
Hull C Construction Phase 1 11/9/20 - The stem pieces are sanded smooth.
-

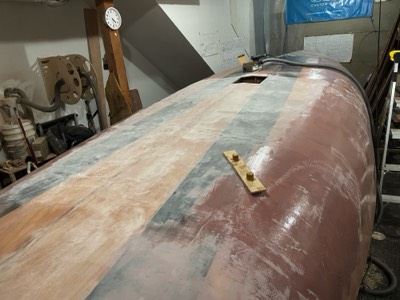

Hull C Construction Phase 1 12/10/20 - The bow is sanded smooth.
-

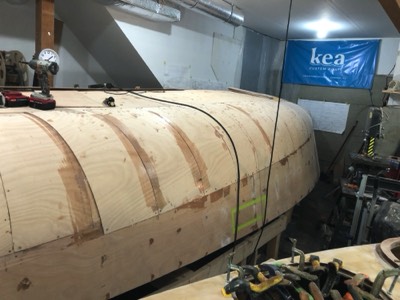

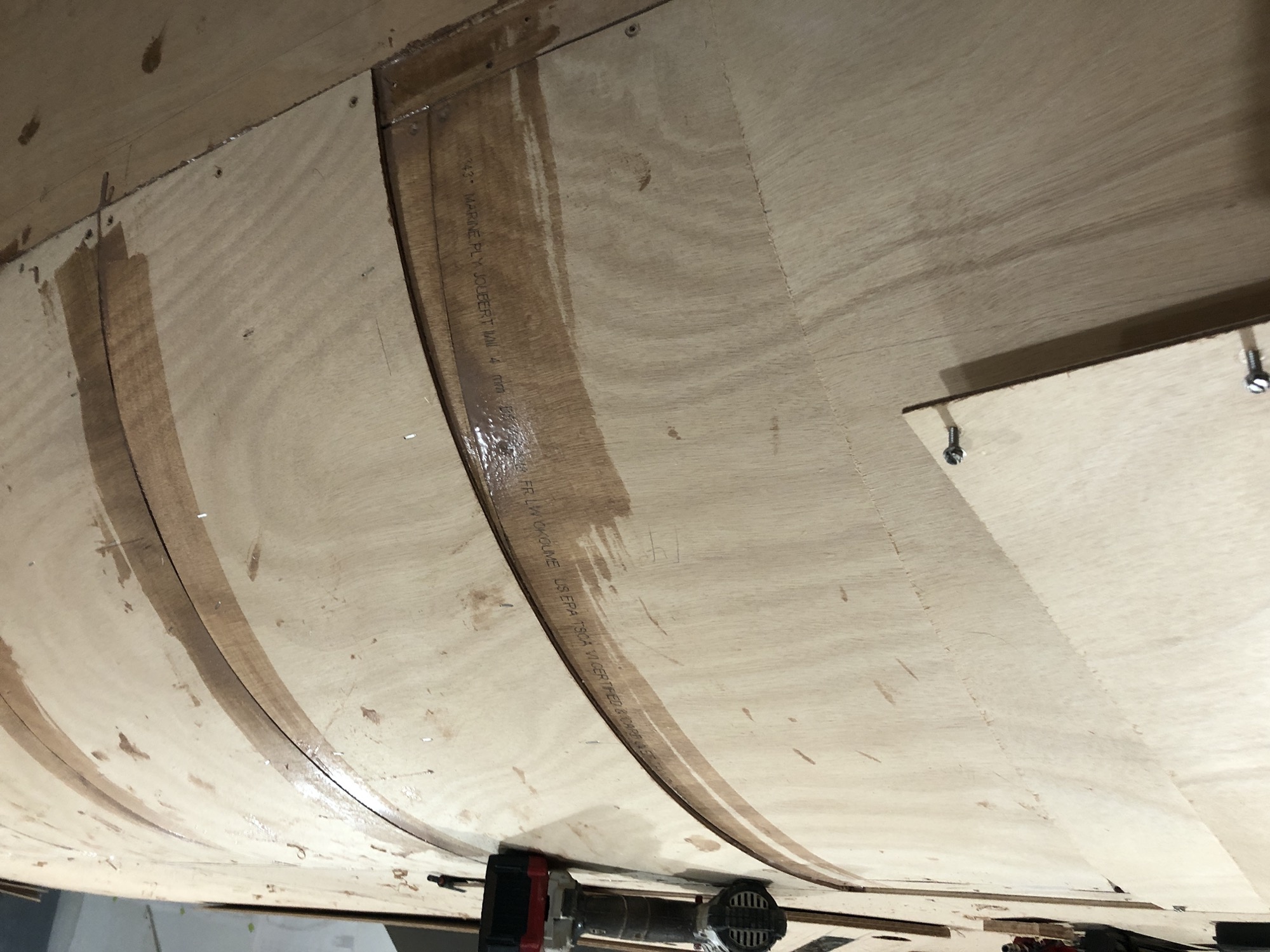

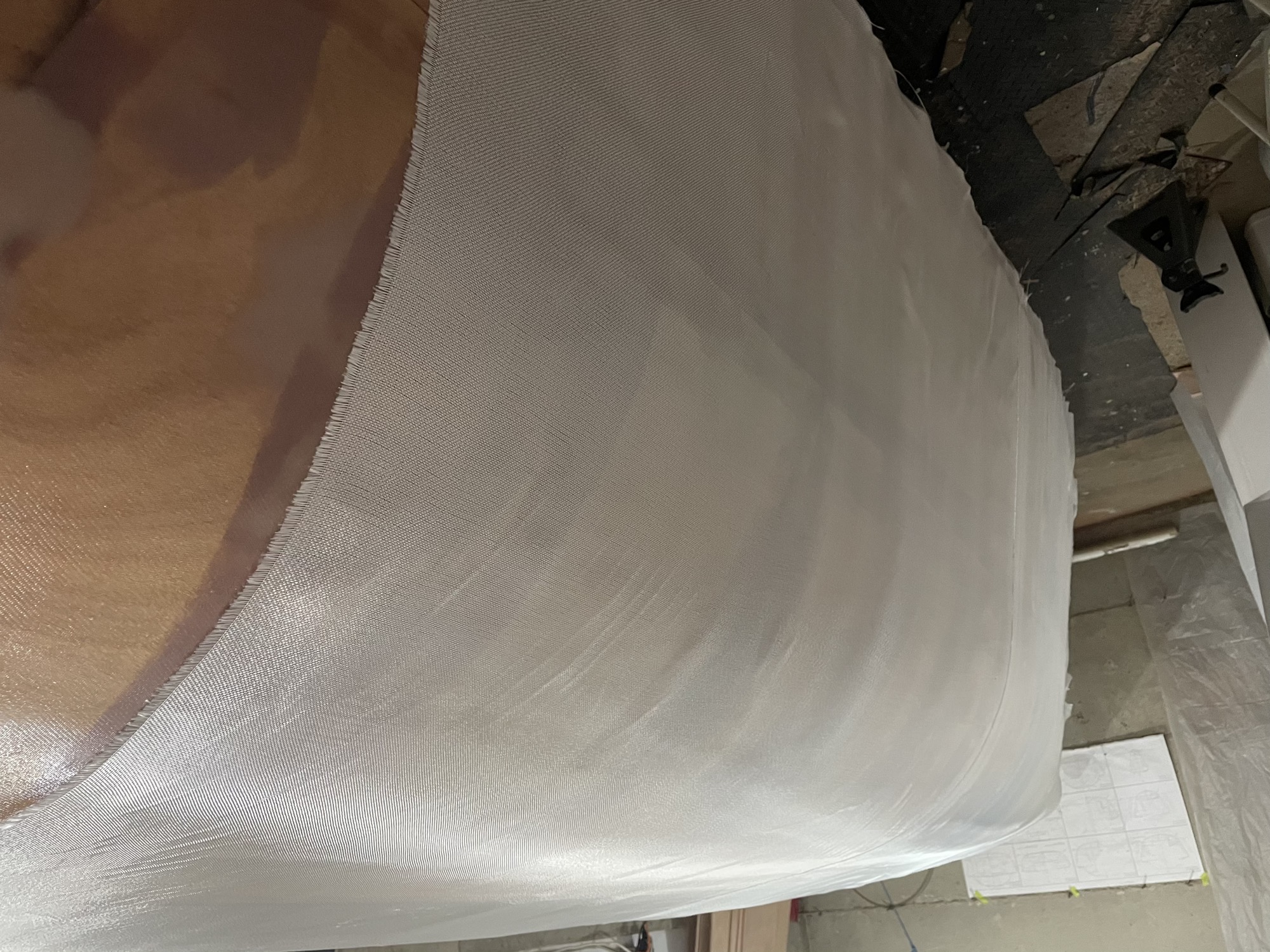

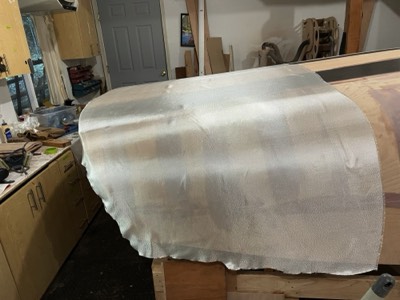

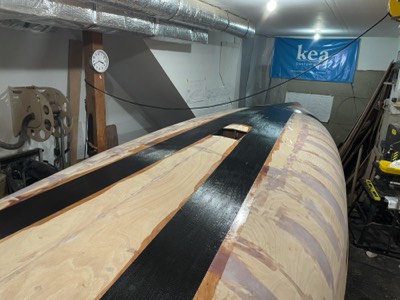

Hull C Construction Phase 1 12/11/20 - The first section of fiberglass cloth is laid on the hull.
-
Hull C Construction Phase 1 Saturated with epoxy.
-

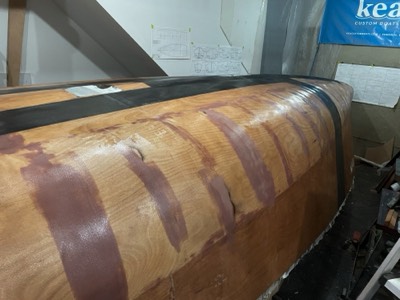

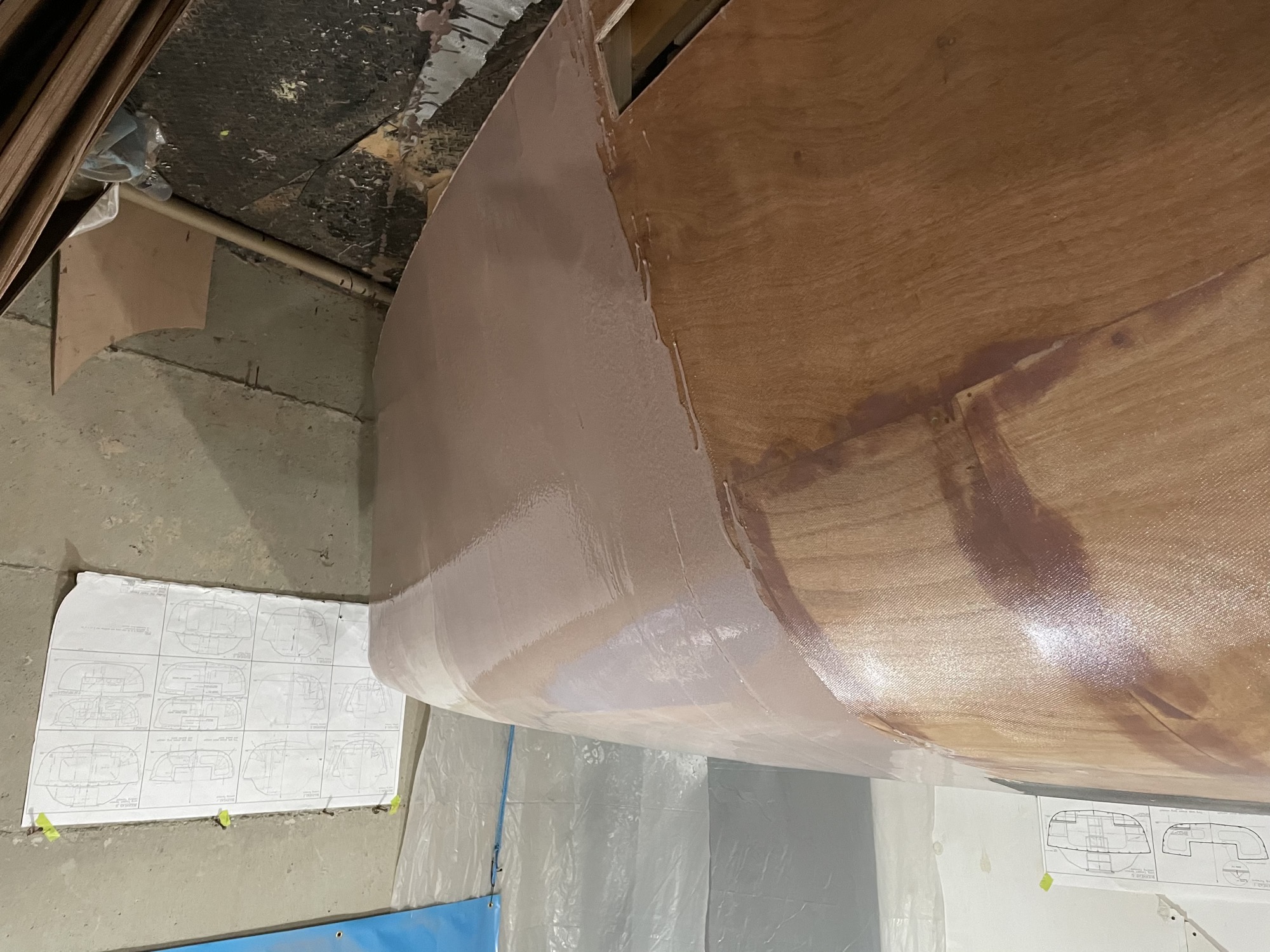

Hull C Construction Phase 1 12/12/20 - The section section of the hull is fiberglassed.
-
Hull C Construction Phase 1 12/15/20 - The rest of the hull is ready for epoxy.
-

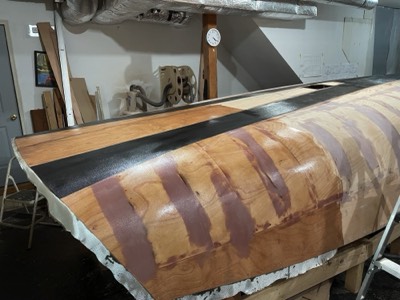

Hull C Construction Phase 1 12/17/20 - The rest of the fiberglass is saturated with epoxy.
-

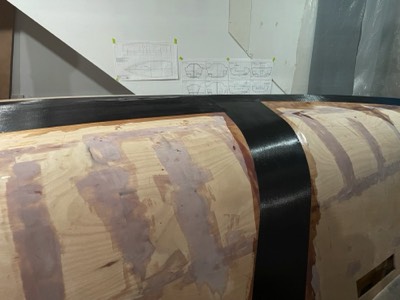

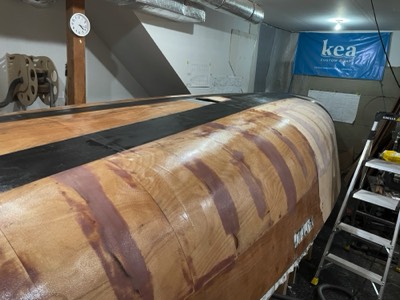

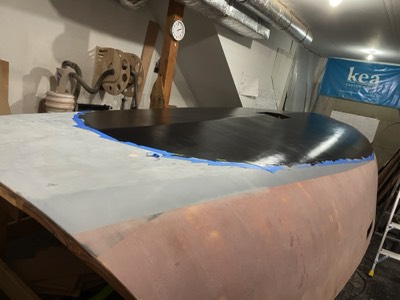

Hull C Construction Phase 1 12/19/20 - Filling the weave of the fiberglass has started.
-

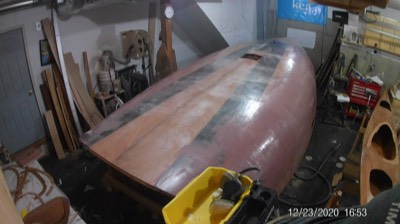

Hull C Construction Phase 1 12/23/20 - Hull construction is complete! Sanding and paint is next.
-
Hull C Construction Phase 1 12/27/20 - Finish sanding has begun!
-
Hull C Construction Phase 1 12/31/20 - Sanding of the bottom and port topsides is done.
-
Hull C Construction Phase 1 1/7/21 - The bottom is ready for primer.
-

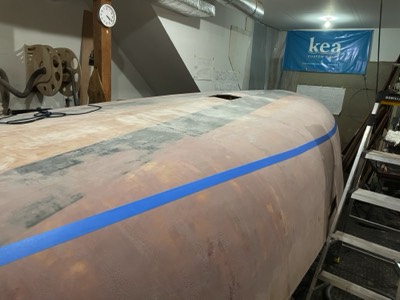

Hull C Construction Phase 1 1/8/21 - The area below the waterline is given two coats of primer.
-

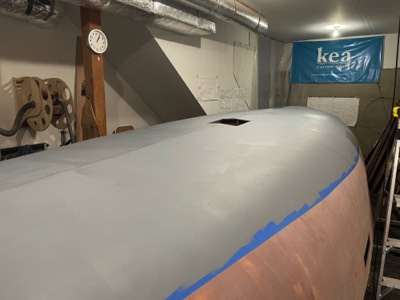

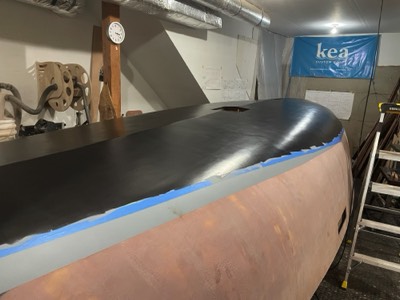

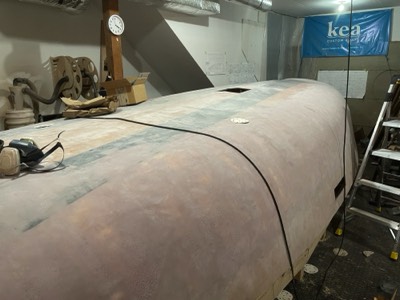

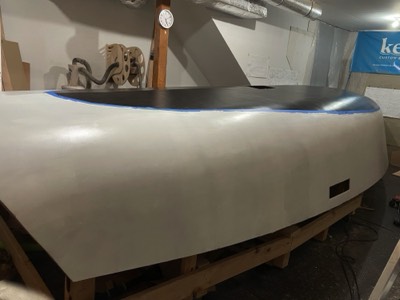

Hull C Construction Phase 1 1/11/21 - After several coats of primer, the first coat of copper free bottom paint is applied.
-
Hull C Construction Phase 1 1/14/21 - Three coats of bottom paint have been applied.
-
Hull C Construction Phase 1 1/16/21 - First coat of topsides primer is applied.
-
Hull C Construction Phase 1 1/18/21 - The primer is sanded.
-

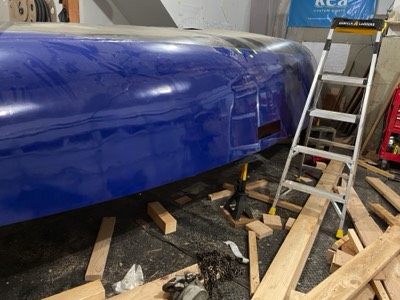

Hull C Construction Phase 1 The first coat of Interlux Perfection is applied.
-

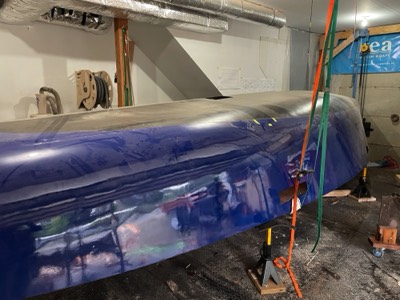

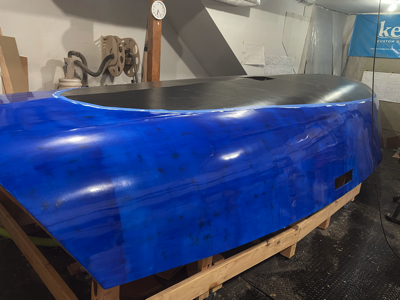

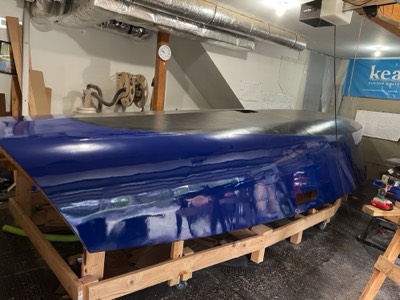

Hull C Construction Phase 1 10/19/21 - Several coats of paint have been applied.
-
Hull C Construction Phase 1 1/23/21 - The strongback is dismantled out from underneath the boat.
-
Hull C Construction Phase 1 The aft hoisting mechanism for the hull turning is set up.
-
Hull C Construction Phase 1 1/24/21 - Everything is ready for the turning.
-
Hull C Construction Phase 1 Halfway through the process.
-

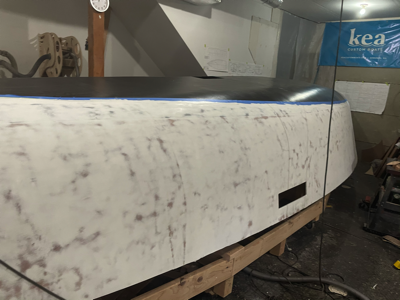

Hull C Construction Phase 1 Turned over and settled in on the cradles.
-
Hull C Construction Phase 1 See the next gallery for interior build photos.
