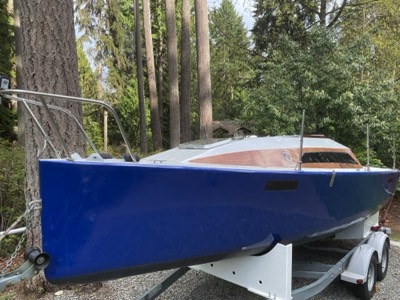

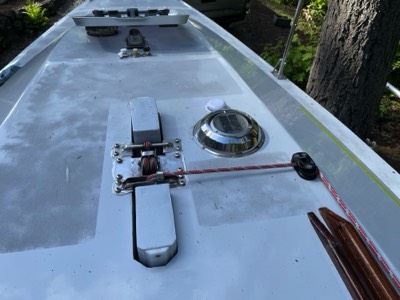

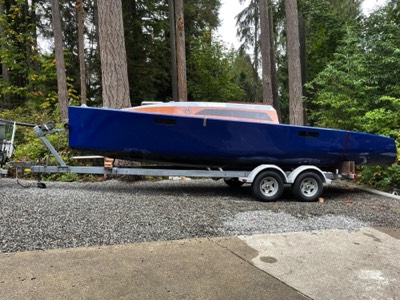

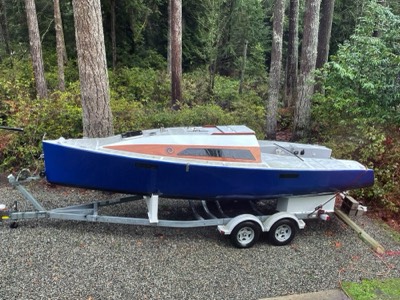

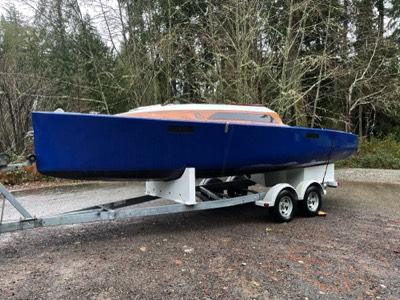

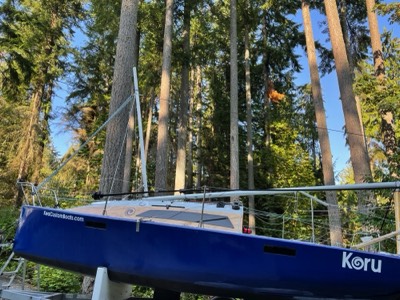

-
Ready for phase 2.
-

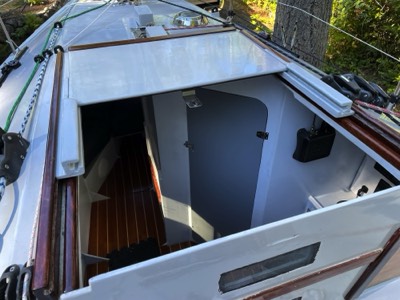

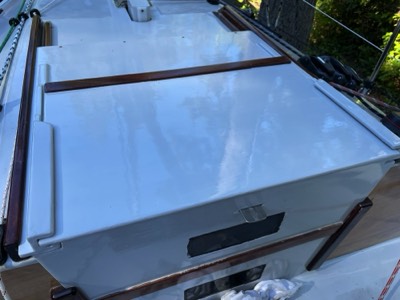

11/1/21 - The flip open sliding companionway hatch is done.
-

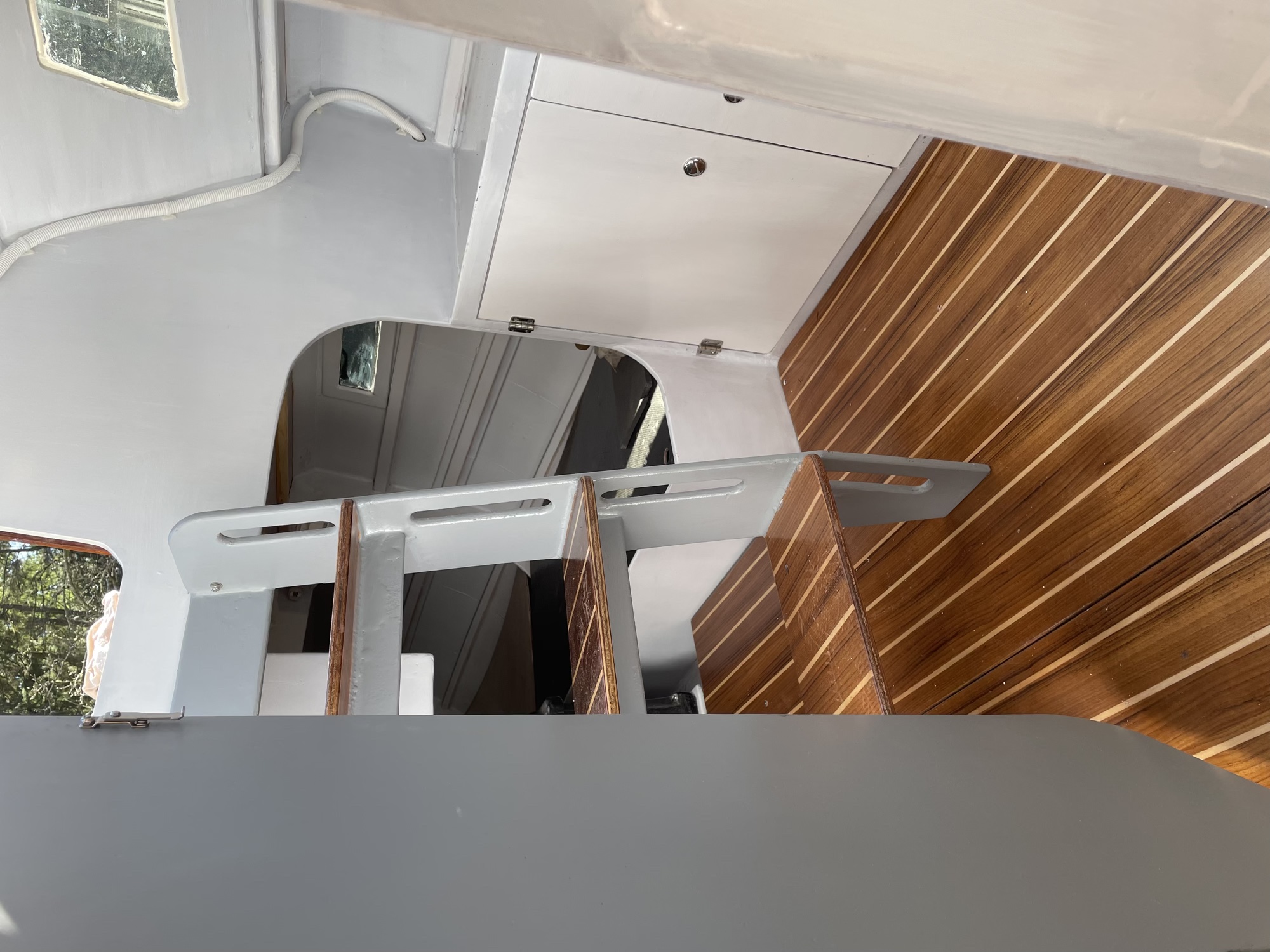

Overall shot with hatch in place.
-

12/21/21 - Painting of the interior is almost done.
-

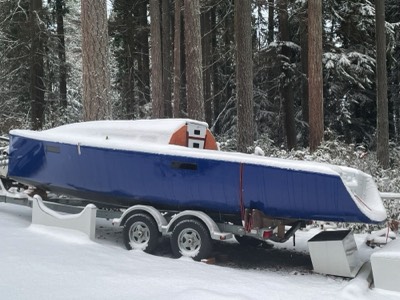

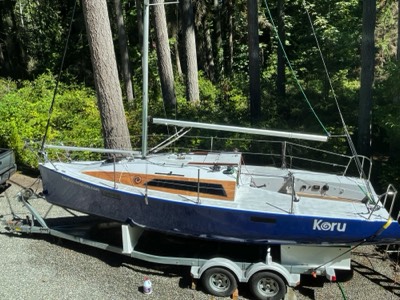

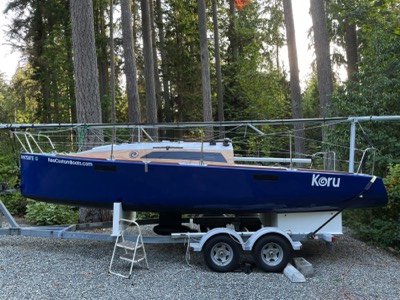

12/26/21 - The Koru sees its first snow.
-
1/1/22 - Getting ready for the custom trailer bunks.
-
1/3/22 - The boat is lifted to make room for bunks.
-

And everything fits! The boat rides higher to create clearance for the lifting keel bulb and the electric pod drive.
-

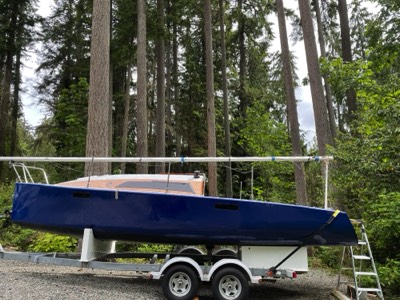

Back in the parking spot.
-

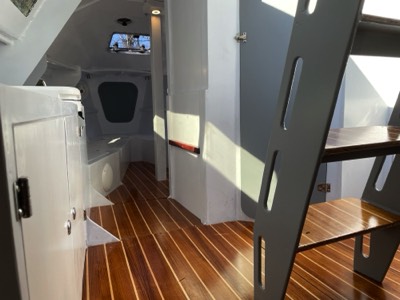

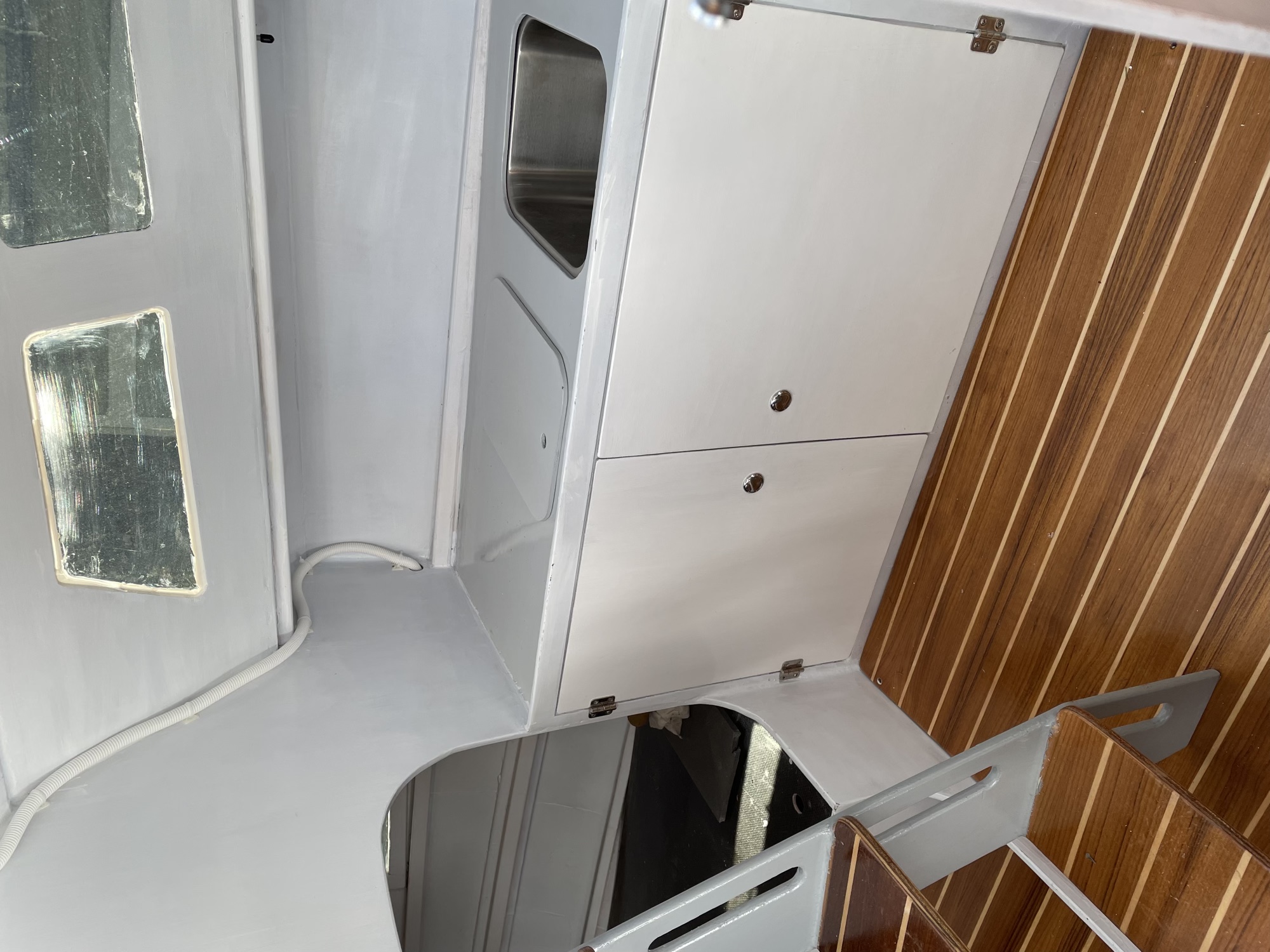

1/5/22 - The interior has been painted with many coats of paint.
-

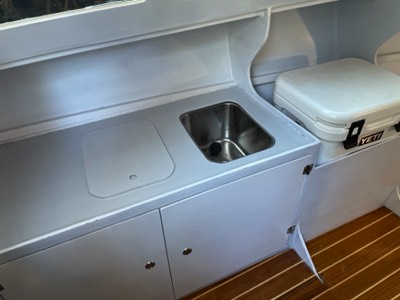

Galley area.
-
2/14/22 - The ePropulsion Pod dreive is mounted.
-

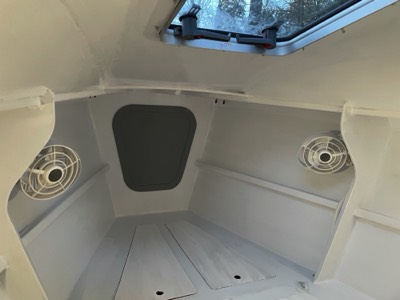

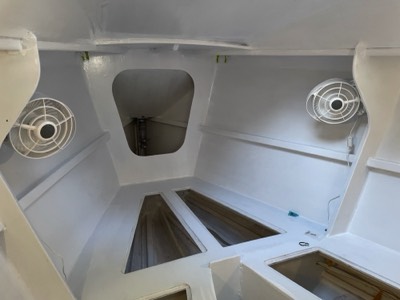

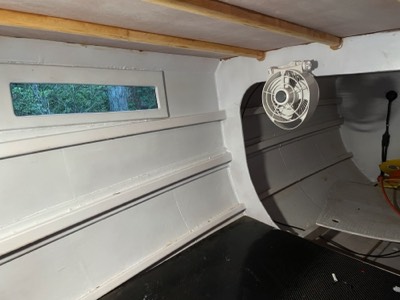

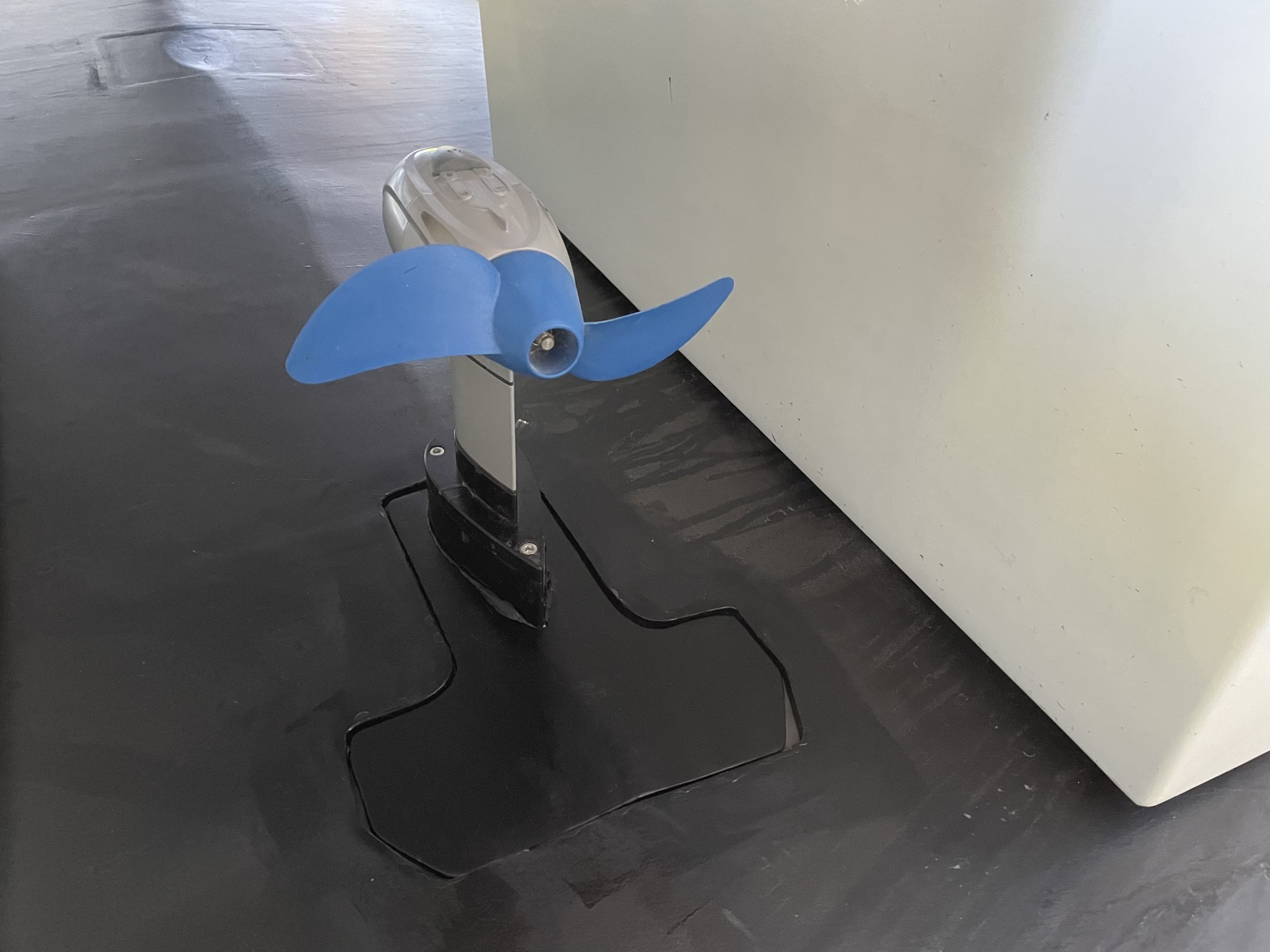

2/21/22 - Fans are mounted in the forward cabin.
-
Fans are mounted in the quarter berths.
-

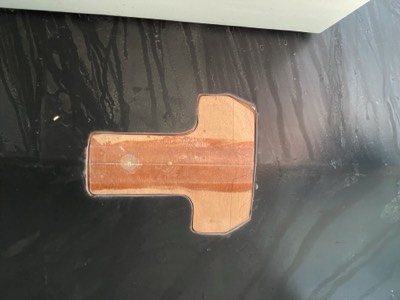

2/24/22 - An important piece of equipment is installed.
-

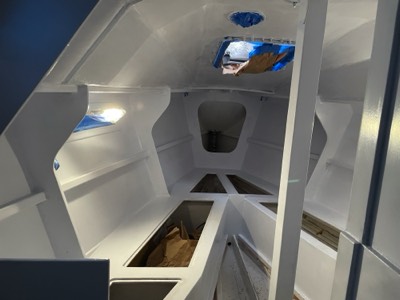

2/25/22 - The forward area of the interior is complete, except for cushions.
-

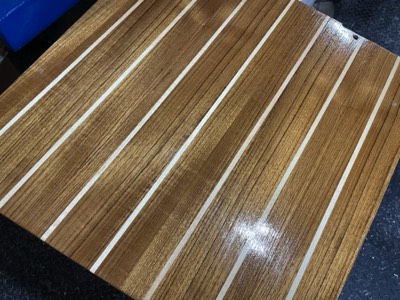

Sections of cabin sole are varnished.
-

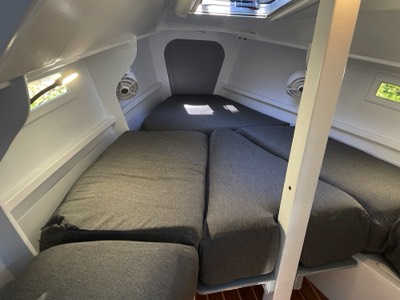

3/6/22 - The forward berth area is complete.
-

3/7/22 - Layup for a carbon fiber tube.
-

3/8/22 - Trimmed and ready for the next step.
-

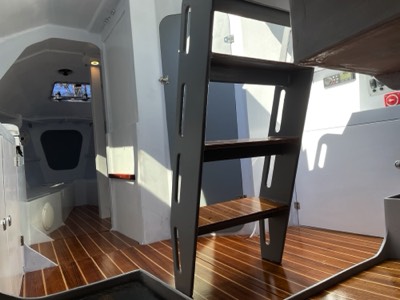

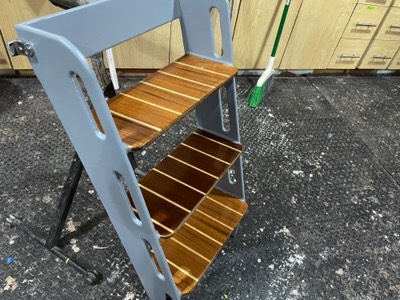

The ladder is painted and varnished.
-

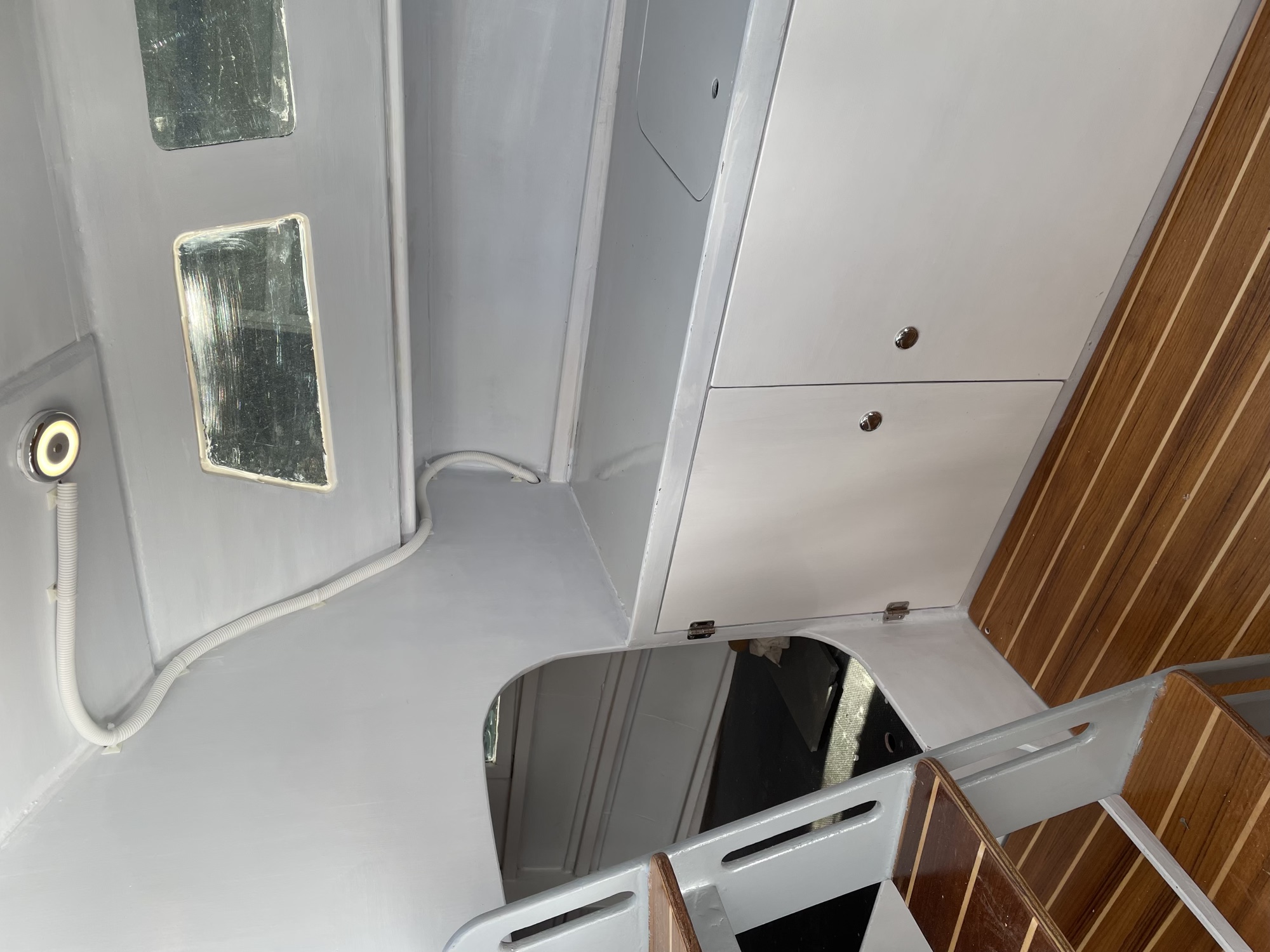

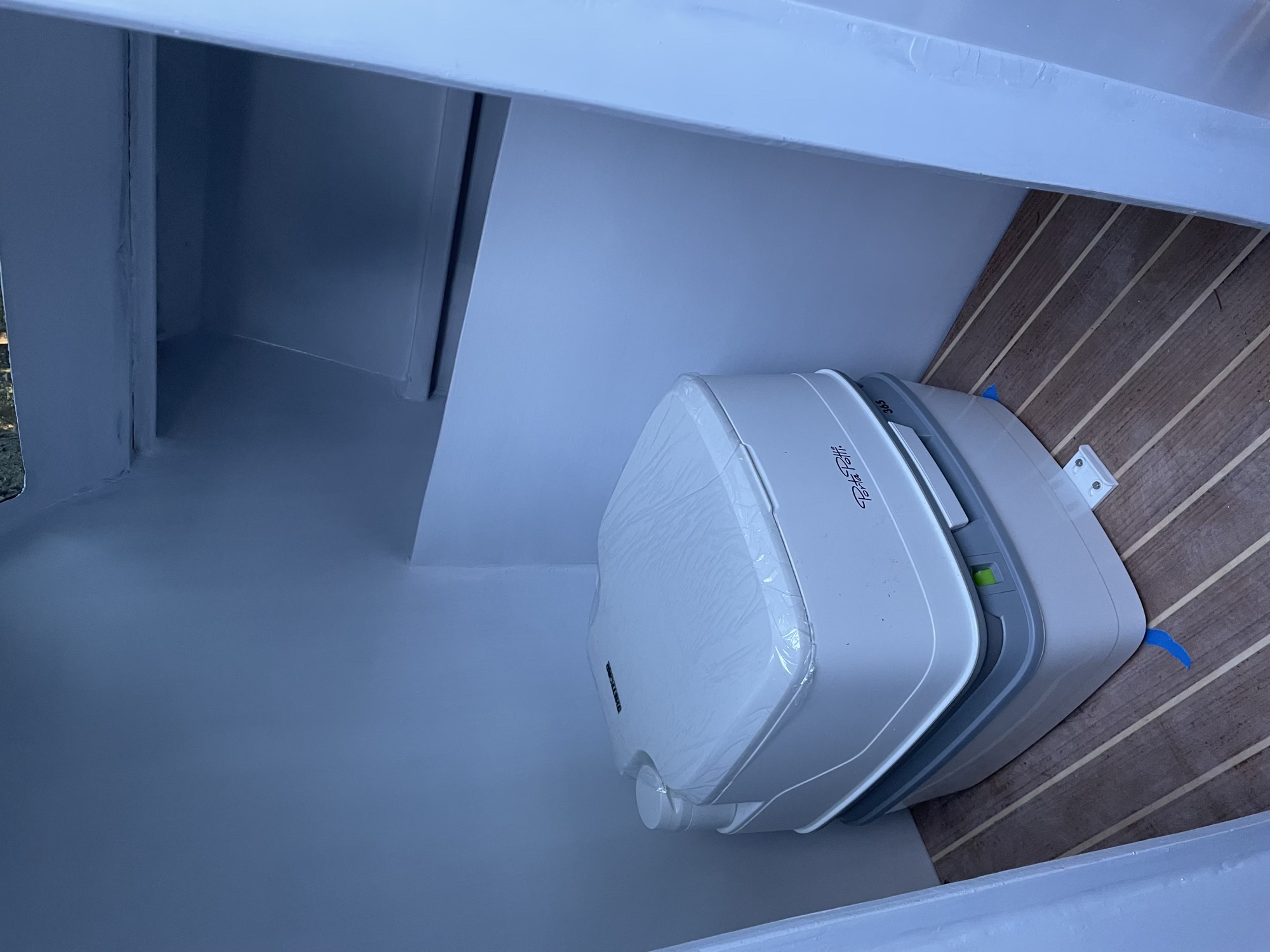

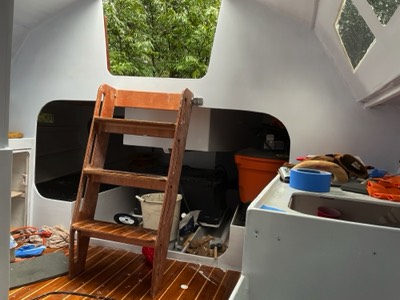

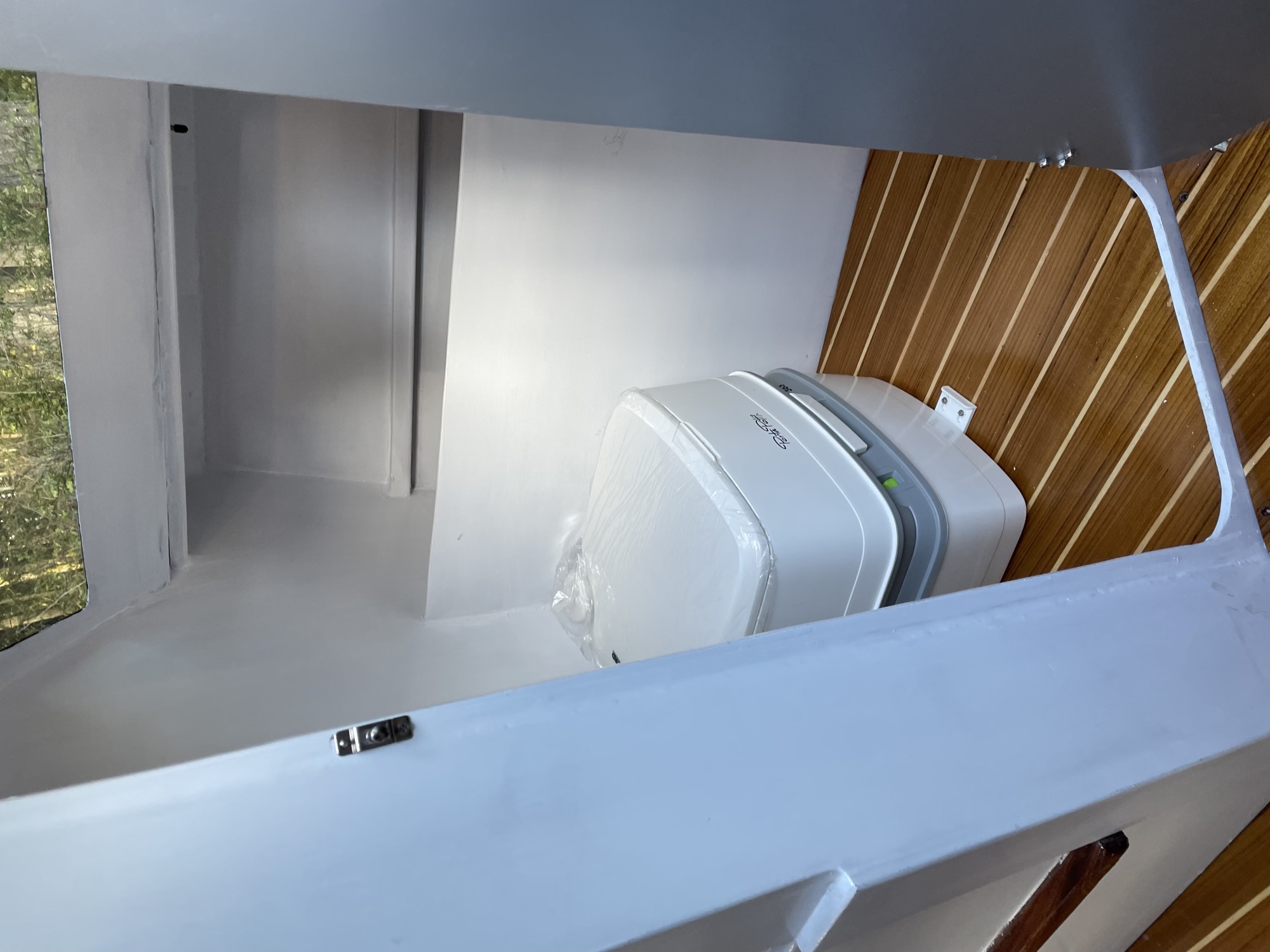

The head compartment is done.
-

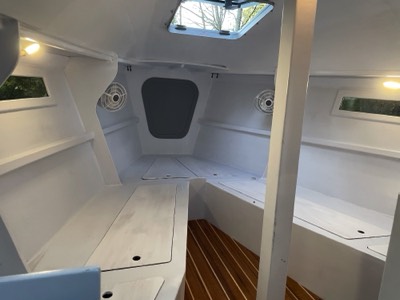

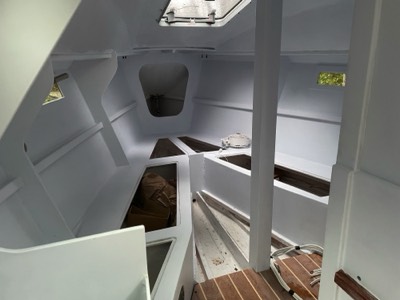

3/9/22 - Phase 1 of the interior construction is done.
-

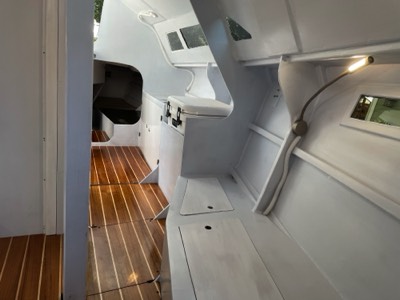

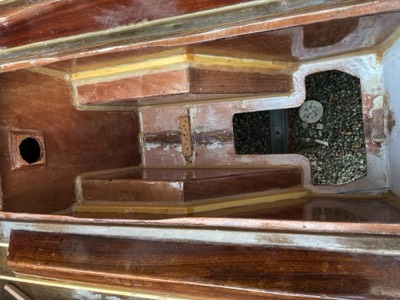

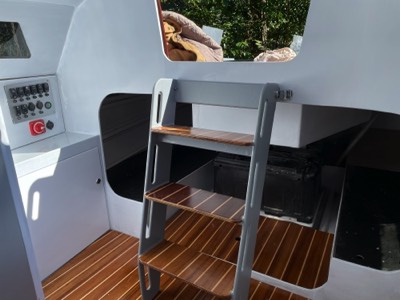

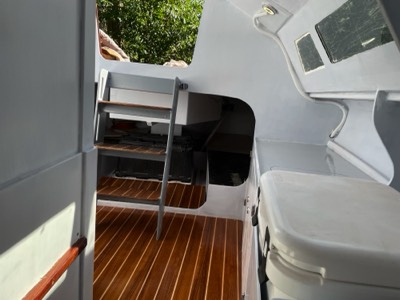

Looking into the quarter berths.
-
From the head into the galley.
-
Galley
-
With sink cutting board removed.
-

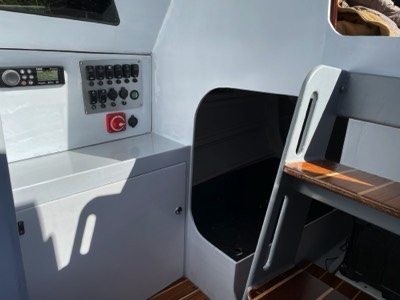

Electronics and chart table.
-
Looking toward the bow.
-
View from quarter berth.
-
View from forward cabin.
-
Galley from the companionway.
-

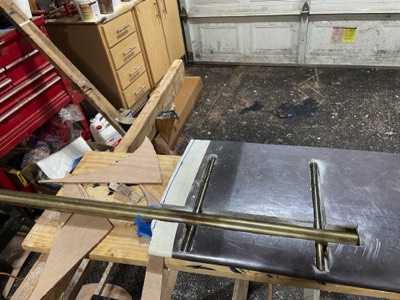

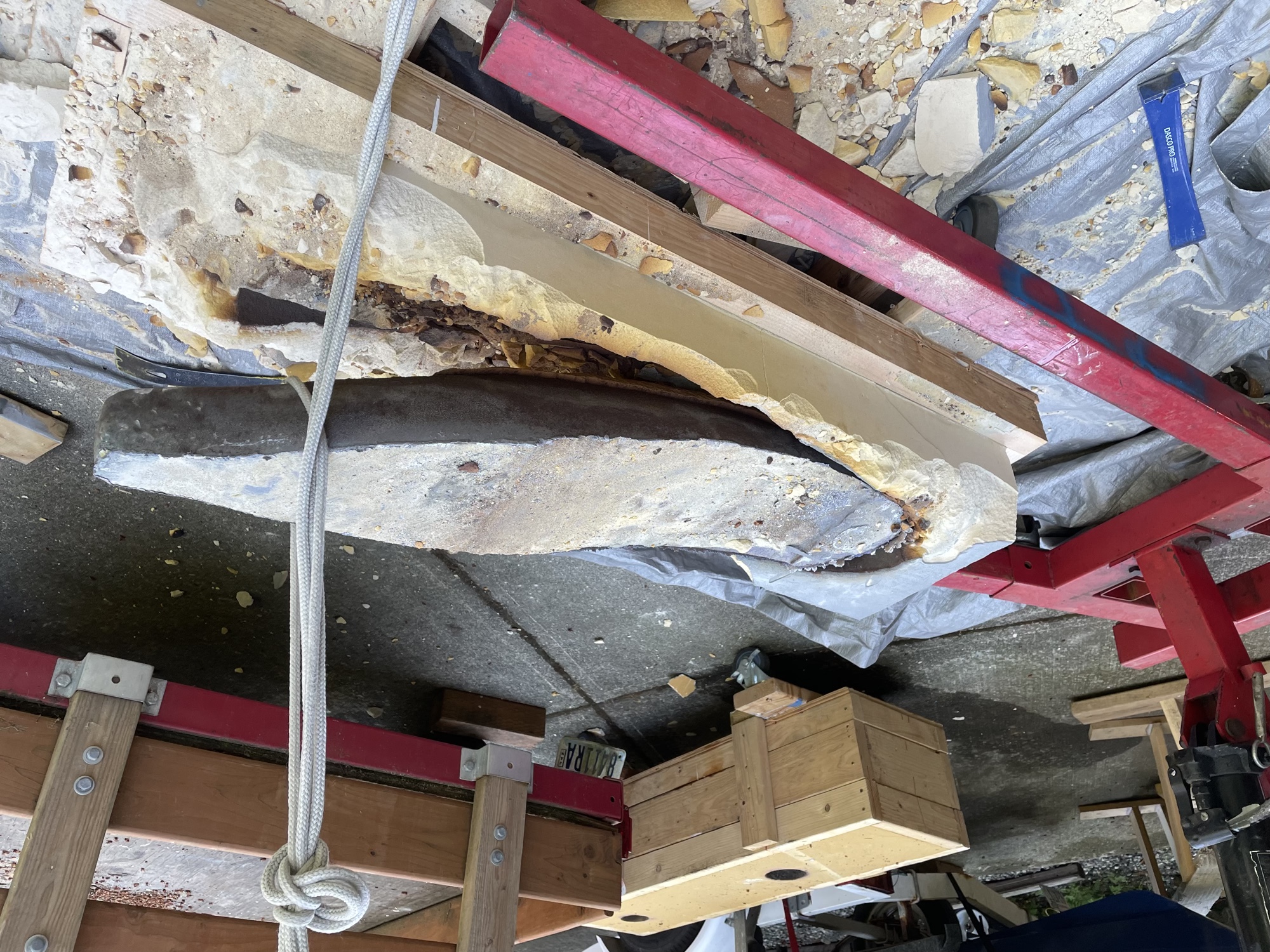

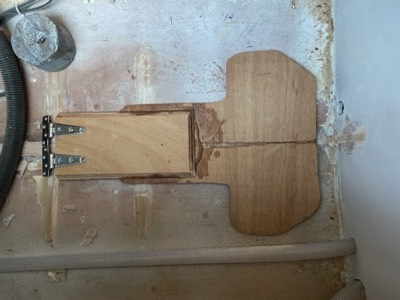

3/10/22 - Rudder from a J24 is cut to accept bronze rudder post.
-
3/12/22 - Cutout is partially filled with epoxy.
-
3/17/22 - Rudder is fiberglassed.
-

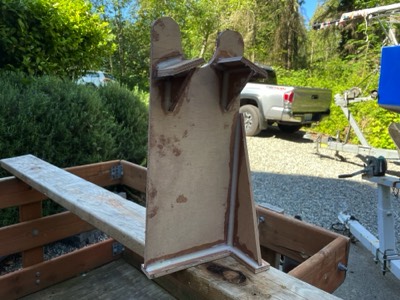

3/21/22 - Rudder support bracket is taking shape.
-

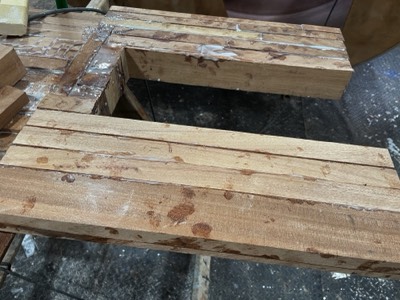

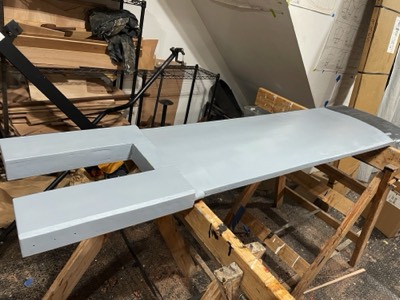

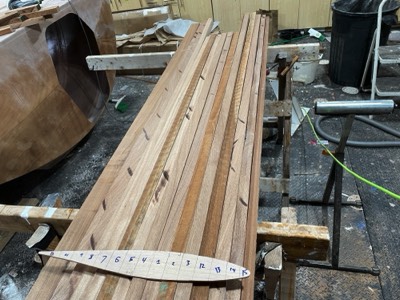

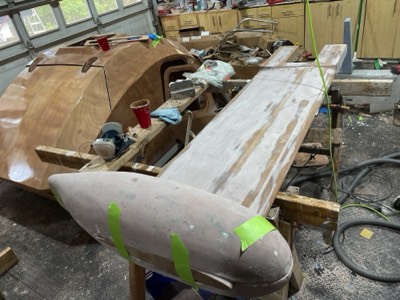

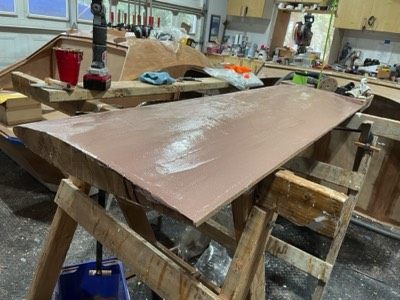

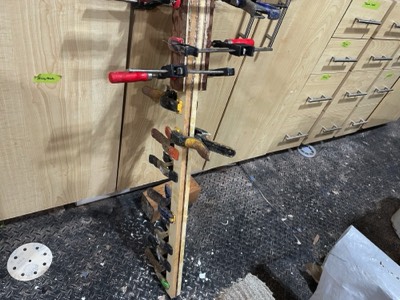

4/4/22 - Strips of sapele are ripped for the keel foil.
-

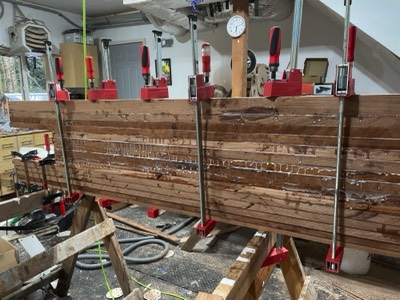

Half of the keel is laminated.
-

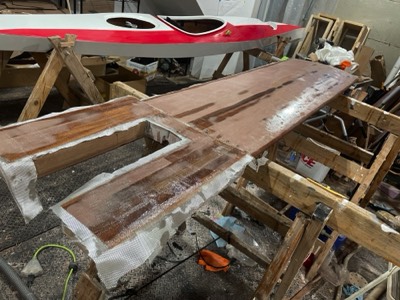

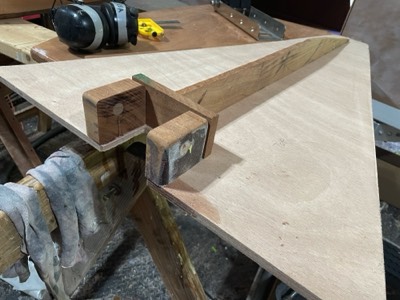

4/5/22 - Slot for the tilt up rudder is cut.
-

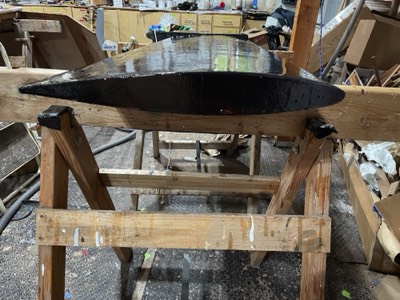

The rest of the keel foil is laminated.
-

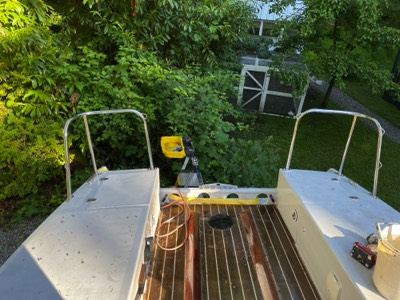

4/9/22 - The pulpit and stanchions are test fit.
-
Deck level view.
-
Now it just needs pushpits.
-
4/12/22 - Pieces of wood are laminated on the upper part of the keel.
-

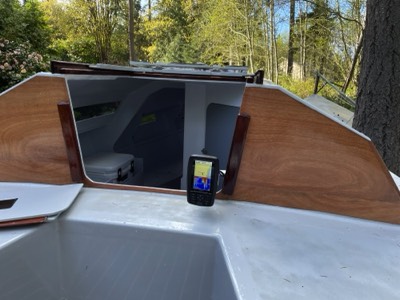

The chartplotter is mounted on the swing arm.
-

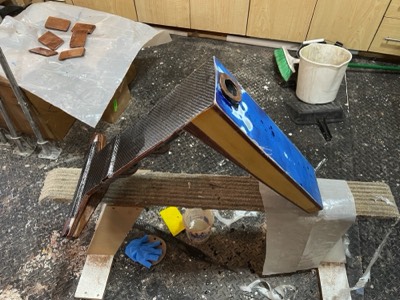

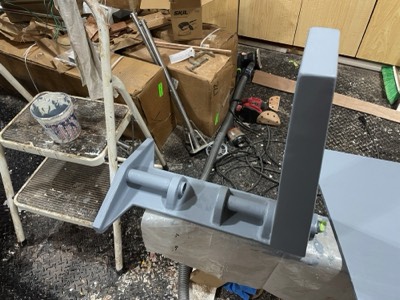

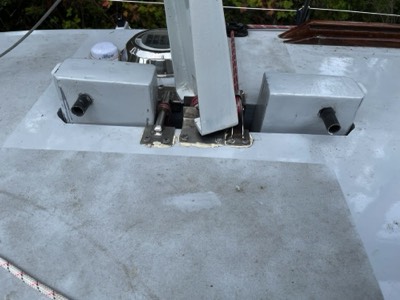

4/11/22 - The rudder bracket is laminated with carbon fiber.
-
4/13/22 - The rudder bracket is primed.
-
Rudder is primed.
-

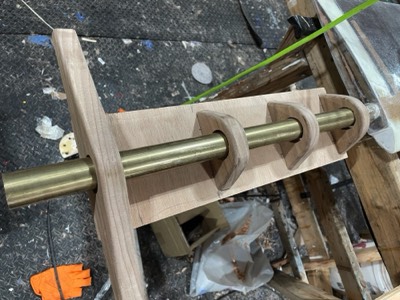

4/14/22 - Rudder bracket hold down pins are test fit.
-
Tip of the rudder is painted red since it will be projecting behind the boat while on the trailer.
-

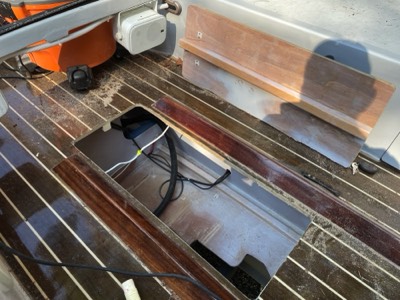

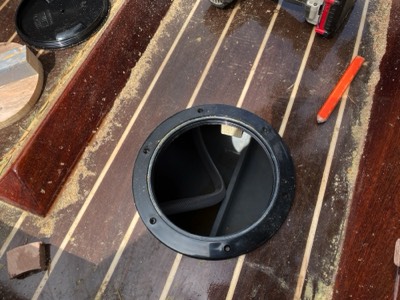

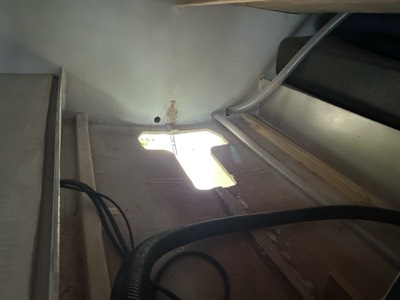

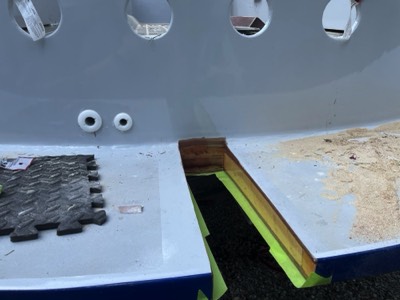

Access hatch is installed in deck.
-
4/16/22 - The rudder cutout is primed.
-

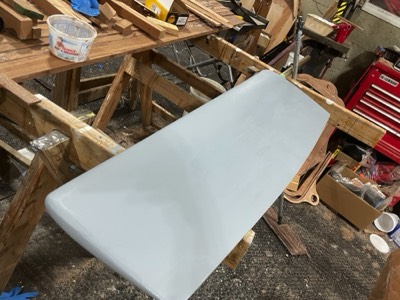

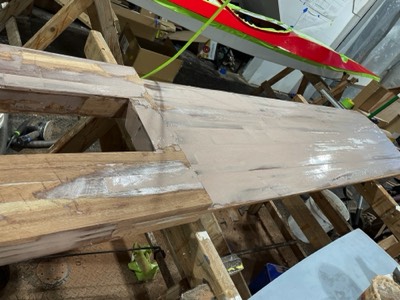

4/17/22 - The keel foil is sanded and filled.
-
4/20/22 - Opposite side of the keel foil is faired with epoxy.
-
4/21/22 - The keel is sanded and the styrofoam lead bulb mold is test fit.
-

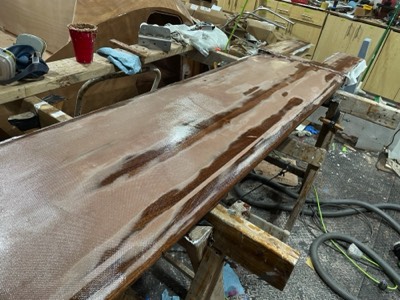

The keel foil is fiberglassed on one side.
-
4/22/22 - The other side of the keel is fiberglassed.
-

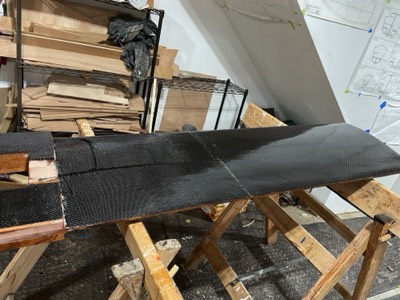

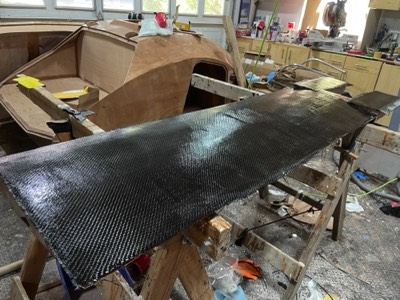

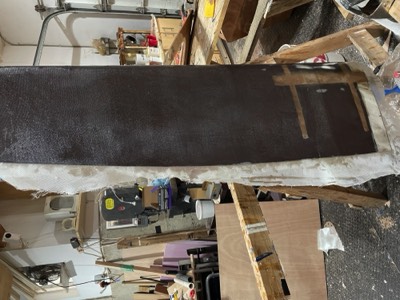

4/23/22 - A layer of 12 oz carbon fiber is added.
-
4/28/22 - Starboard side of the keel foil is covered with carbon fiber.
-

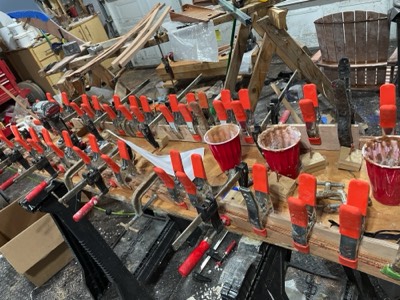

Tiller is laminated from sapele and Alaskan yellow cedar.
-

Lines are taken for the forward berth table/berth support.
-
Epoxy with graphite powder is applied.
-
A nice NACA foil shape.
-

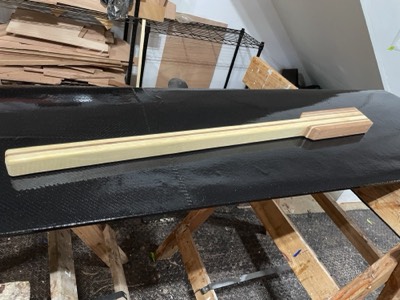

4/29/22 - The tiller is sanded and rounded.
-
Rudder cutout is painted.
-
5/3/22 - Tiller is epoxy sealed.
-
5/12/22 - Lifeline stanchions are temporarily installed.
-

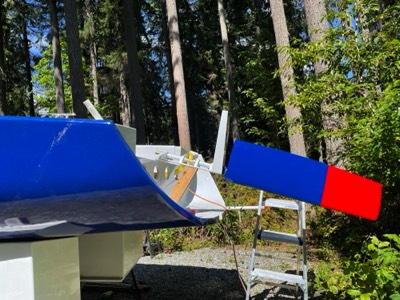

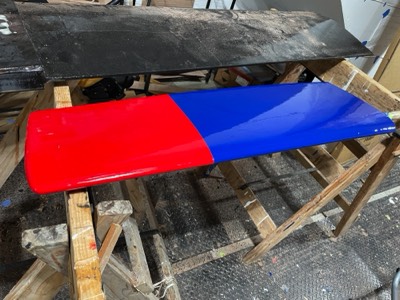

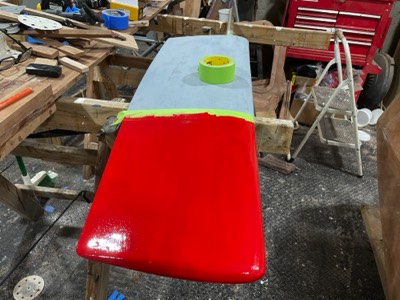

Painting of the rudder is complete. The tip is red because it will be sticking out beyond the stern when tilted up.
-
5/12/22 - Tilting rudder mount is installed.
-

5/23/22 - Table/berth support is cut out and test fit.
-
Support pieces for table are cut out.
-
5/24/22 - Port side of the keel foil is primered.
-

5/25/22 - The table/berth support is mounted on the mast support.
-
Mounted in the berth position.
-
Rudder is test fit in the tilted position for launch and recovery.
-

5/26/22 - Keel foil is painted with hard bottom paint.
-
5/27/22 - New retractable trailer straps are installed.
-
5/30/22 - The keel lifting footblock is temporarily mounted.
-

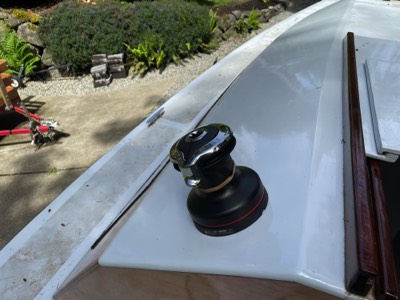

Winches are temporarily mounted.
-
Table/berth support is painted.
-

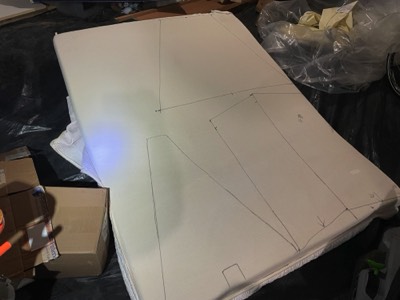

Cushion patterns for forward berth are traced out on a mattress.
-

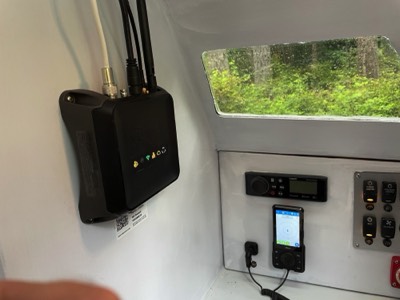

6/4/22 - VHF/AIS system is installed.
-
6/5/22 - Starboard winch, clutch, and footblcok for keel lifiting are installed.
-

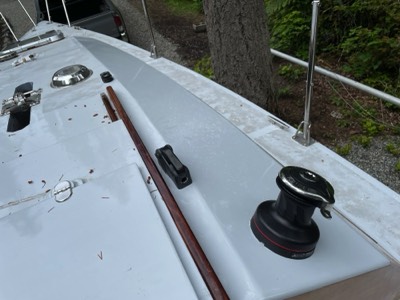

Stanchions and pulpit are installed.
-

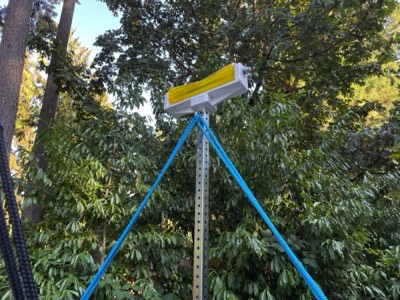

6/8/22 - Mast crutch is tested using temporary mast.
-

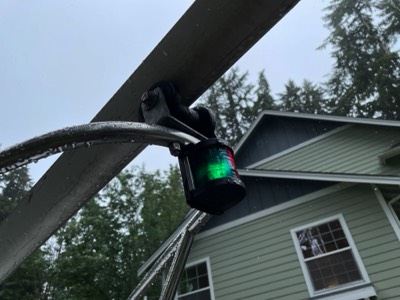

6/9/22 - Navigation lights on pulpit are wired and tested.
-

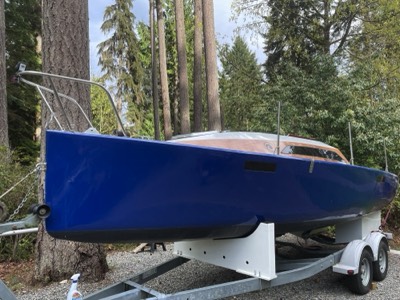

6/11/22 - She's coming along!
-
Mast crutch system testing.
-
Custom pushpits are mounted.
-
Railing system is complete. Just add lifelines.
-

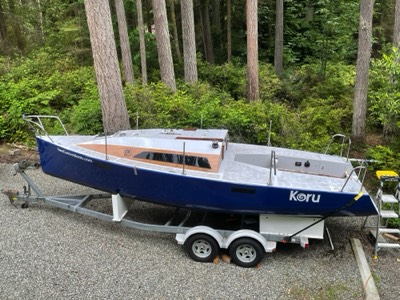

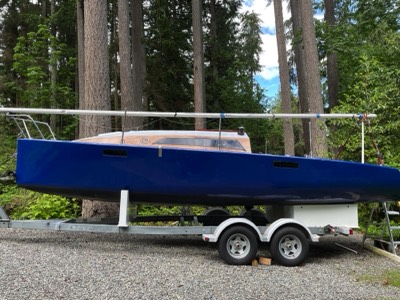

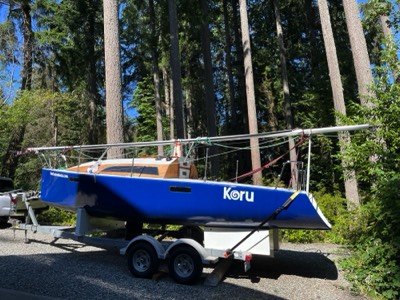

6/12/22 - The names are added!
-
View from above of names.
-

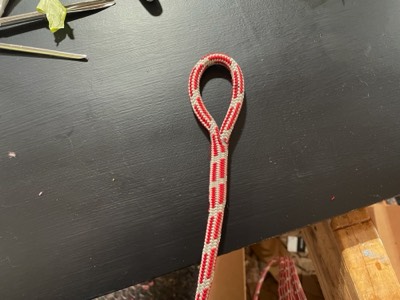

6/21/22 - Eye splice is created in keel lifting line.
-
The keel lifting system and keel foil are installed.
-
Keel in partially lowered position.
-

6/23/22 - Forward cabin table/berth is installed.
-
Table in lowered postion.
-

6/23/22 - The boat is at the riggers for mast and standing rigging.
-

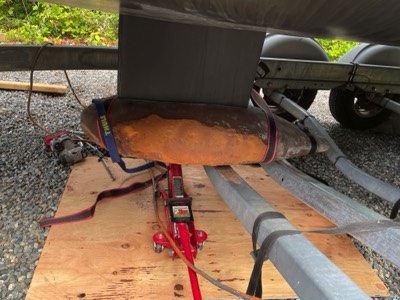

7/18/22 - Beginning the process of getting the keel bulb out of the form.
-
Almost out.
-
Half of the keel bulb is out.
-
7/29/22 - Trying my hand at sewing cushion covers.
-
7/30/22 - Two more cushions.
-
8/8/22 - She's home from the riggers.
-

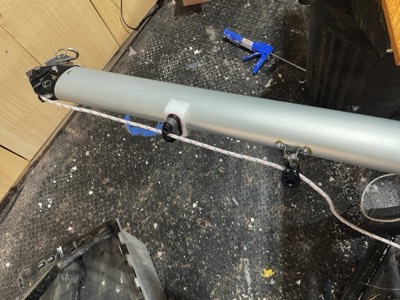

8/9/22 - The 5:1 internal outhaul system is installed in the boom.
-
8/11/22 - Mid mast support is made.
-

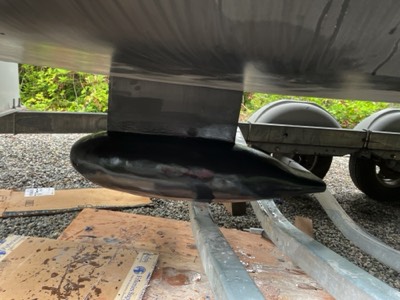

8/15/22 - Right side of the keel bulb is in place.
-
8/16/22 - Left side of the keel bulb is in place.
-

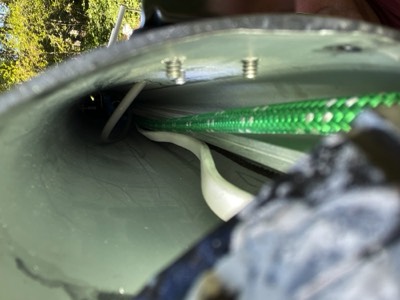

8/17/22 - Wires for antenna and masthead light are run through the mast.
-

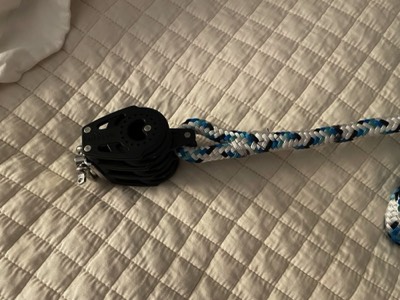

Main sheet block is spliced onto the mainsheet.
-
8/29/22 - The bulb is bolted to the keel foil and then gaps are filled with epoxy.
-
8/30/22 - Blackout shade is installed on hatch.
-
Also serves as a fly screen.
-

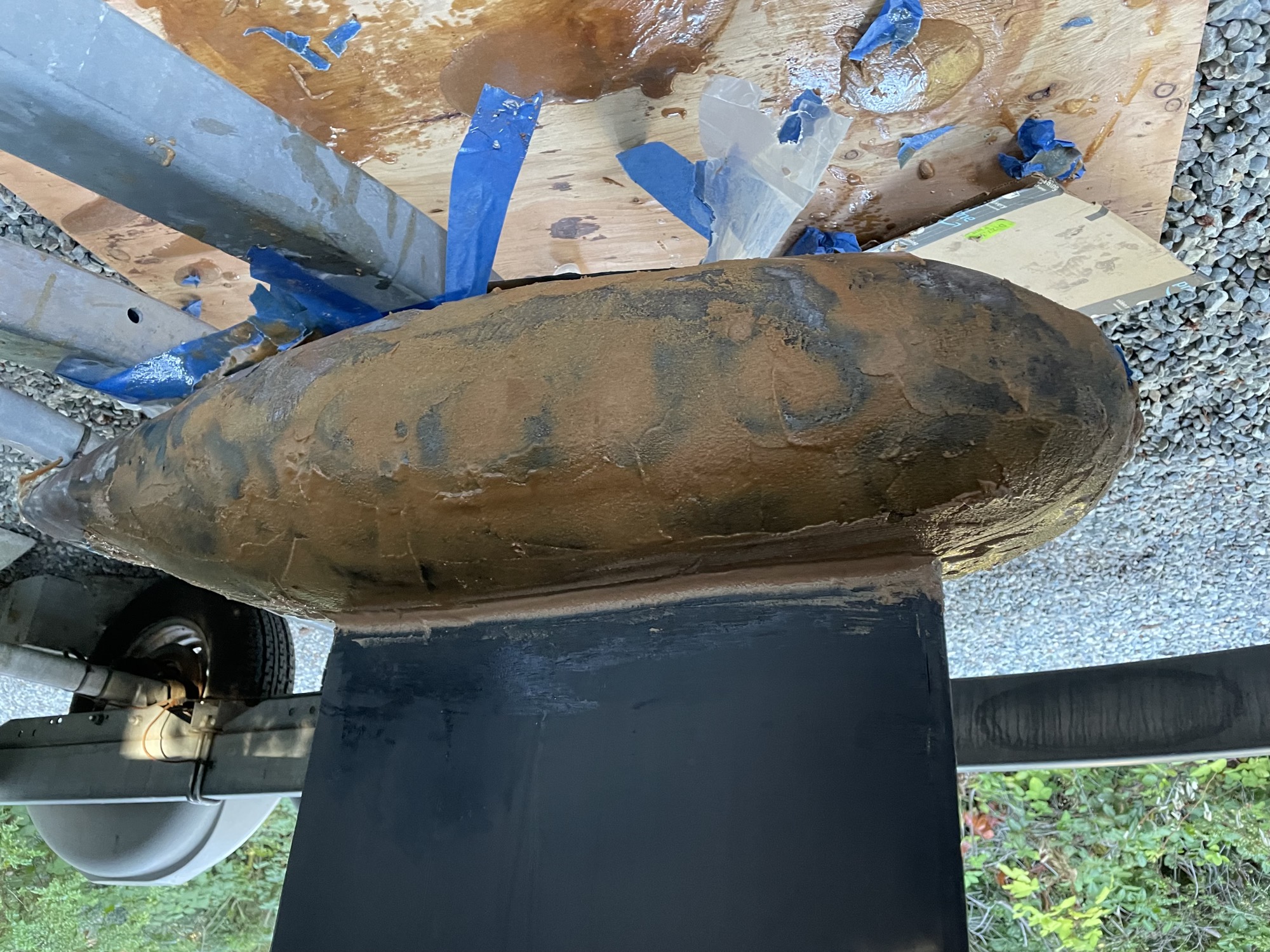

Bulb is covered with epoxy and fairing additive.
-

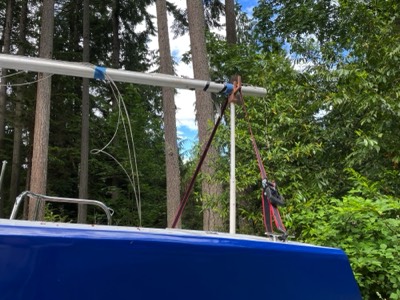

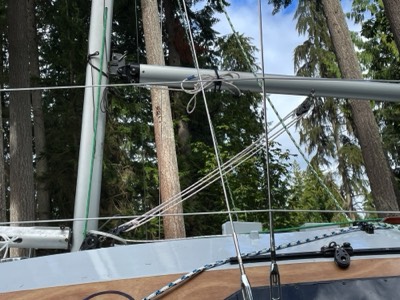

9/1/22 - Mast raising system is tested out.
-

9/2/22 - The mast is up.
-

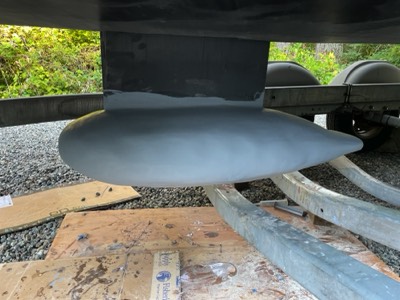

Bulb is given a coat of primer.
-
9/3/22 - First coat of antifoul paint on the bulb.
-
9/4/22 - Boom vang is installed.
-
9/4/22 - Just need some sails!
-
9/2/22 - The quarter berth is done.
-
Boom kicker is installed.
-

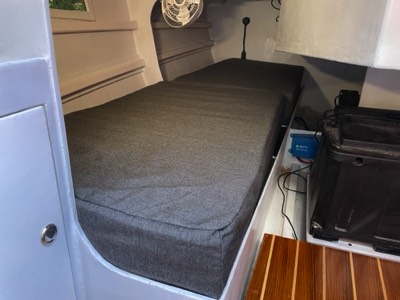

9/6/22 - The forward berth cushions are done.
-
She's ready for the Wooden Boat Festival!
-

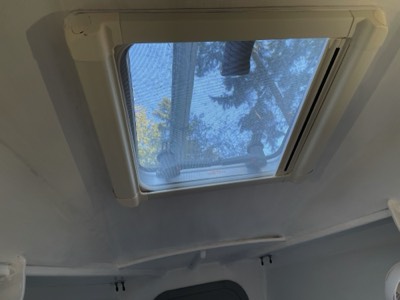

New double slider hatch is installed.
-
Closed hatch.
-

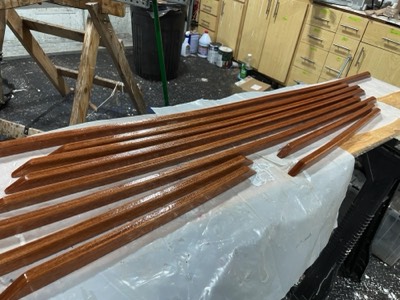

9/16/22 - Toe rails are laminated from sapele.
-
Toe rails are epoxy sealed.
-
9/16/22 - The toe rails are test fit on the boat.
-

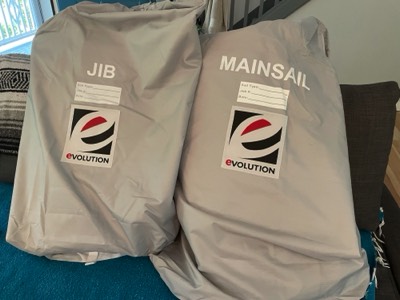

The sails have arrived!
-
9/18/22 - Improved mast crutch is ready.
-
9/19/22 - Jib is installed on the roller.
-

Jib is unfurled.
-
View of jib furled.
-
Main is raised for the first time. No battens were installed for this.
-
Cunningham is installed.
-

Both sails are up.
-
9/20/22 - Improved mast raising and lowering system works great.
-
9/30/22 - Hole is cut for retractable motor.
-
10/1/22 - Hole is cut in cockpit sole for access to motor.
-
10/2/22 - Motor door is test fit.
-
A little adjustment needs to be done.
-
Plug for sailing is test fit.
-
10/4/22 - lip to support access hatch is epoxied in place.
-
10/5/22 - Motor well walls are test fit.
-
Wall parts are fiberglassed.
-
10/6/22 - Motor well walls are test fit again.
-
10/9/22 - The forward wall of the motor well is mocked up.
-
All the joints in the motor well are filletted.
-

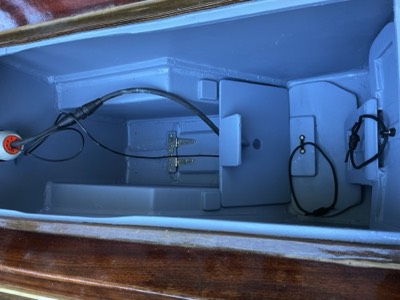

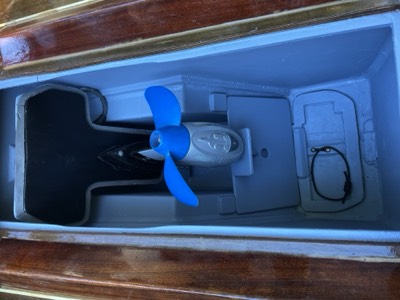

10/10/22 - View of pod drive temporarily mounted.
-

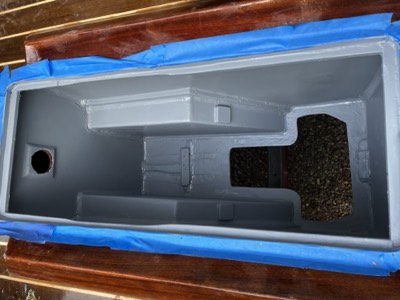

The motor well is primed with a barrier coat primer.
-

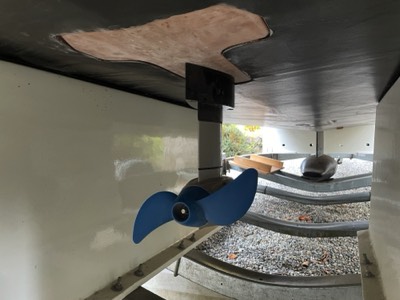

10/11/22 - The motor is mounted and in the retracted position.
-
The motor is locked in the down position.
-

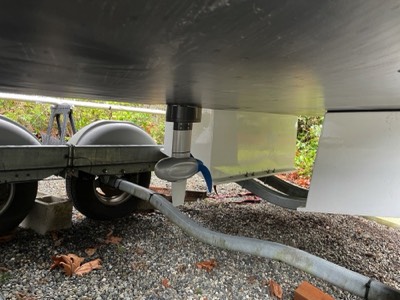

The motor seen from below.
-
Cockpit sole hatch is in place.
-
10/23/22 - The final step of construction. Holes for the keel safety pins were drilled when the boat was launched. Now filled with carbon tubes which will be cut off.
